|
Audit and Risk Committee Tuesday 19 May 2026 at 10:00 am
|
|
|
|
|
19 May 2026
Audit and Risk Committee Agenda
Meeting to be held in the Council Chamber
36 Water Street, Whangārei
on Tuesday 19 May 2026, commencing at 10:00 am
Recommendations contained in the agenda are NOT decisions of the meeting. Please refer to minutes for resolutions.
MEMBERSHIP OF THE Audit and Risk Committee
Chairperson (Independent Tangata Whenua Member), George Riley
|
Councillor John Blackwell |
Councillor Joe Carr |
Councillor John Hunt |
|
Councillor Colin Kitchen |
Ex-officio Pita Tipene |
Independent Tangata Whenua Member Dee-Ann Wolferstan |
|
Independent Risk Advisor Steve Watene |
|
|
KARAKIA / WHAKATAU
RĪMITI (ITEM) Page
1.0 Ngā Mahi Whakapai/Housekeeping
2.0 Ngā Whakapahā/apologies
3.0 Ngā Whakapuakanga/declarations of conflicts of interest
4.0 Ngā Whakaae Miniti / Confirmation of Minutes
4.1 Confirmation of Minutes - 17 February 2026 4

5.1 Receipt of Action Sheet 10

5.2 Auditors Report – Management Response to Deloitte Recommendations 13
6.1 Review Terms of Reference 21
6.2 2025-26 Annual Report: Timetable and Deloitte Planning Report 24
6.3 Financial Report April 2026 58
6.4 Risk Management Activity Update 67

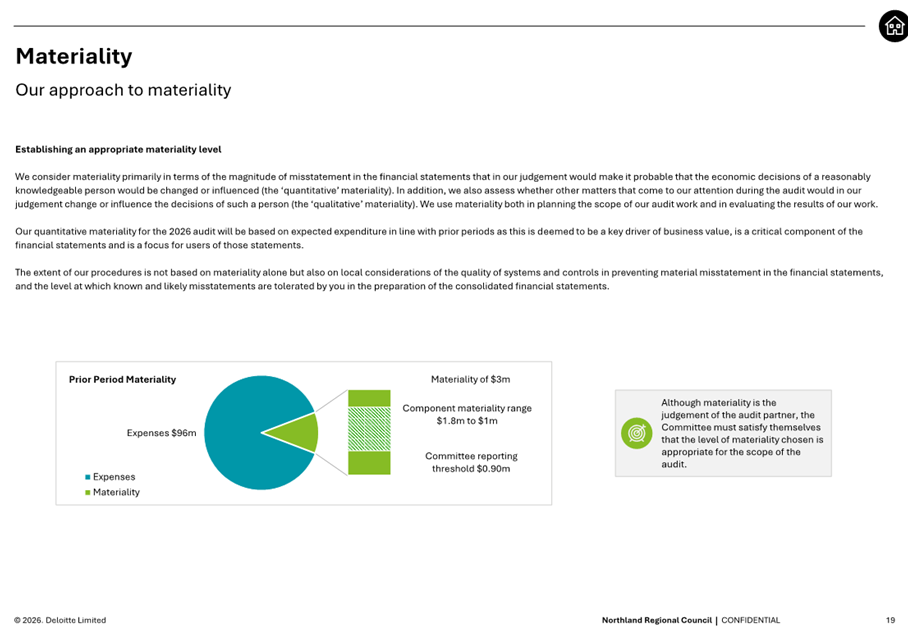

6.5 Internal Audit Schedule 77
6.6 Fraud, Corruption and Dishonesty Activity Report 81
6.7 Regulatory Services Quarterly Report 85
7.0 Kaupapa ā Roto / Business with the Public Excluded 101
7.1 Confirmation of Confidential Minutes - 17 February 2026
7.2 Receipt of Confidential Action Sheet
7.3 Litigation Schedule Quarterly Report January-March 2026
Audit and Risk Committee item: 4.1
19 May 2026
|
TITLE: |
Confirmation of Minutes - 17 February 2026 |
|
From: |
Margaret Knight, PA to Group Manager Corporate Services |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
That the minutes of the Audit and Risk Committee meeting held on 17 February 2026 be confirmed as a true and correct record and that these be duly authenticated with the Chair’s electronic signature.
Attachments/Ngā tapirihanga
Attachment 1:

Confirmation of Minutes - 17 February 2026 ⇩
Audit and Risk Committee item: 5.1
19 May 2026
|
TITLE: |
Receipt of Action Sheet |
|
From: |
Margaret Knight, PA to Group Manager Corporate Services |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
The purpose of this report is to enable the meeting to receive the current action sheet.
That the action sheet be received.
Attachments/Ngā tapirihanga
Attachment 1:
Action Sheet ⇩
Audit and Risk Committee item: 5.2
19 May 2026
|
TITLE: |

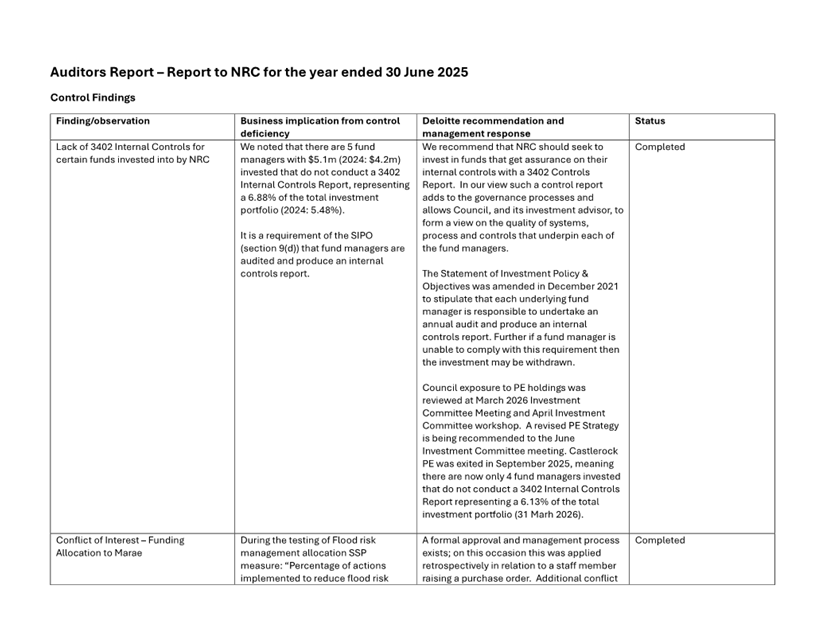

Auditors Report – Management Response to Deloitte Recommendations |
|
From: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 13 March 2026 |
Whakarāpopototanga / Executive summary
The purpose of this report is to enable the meeting to receive the current action sheet.
That the action sheet be received.
Attachments/Ngā tapirihanga
Attachment 1:

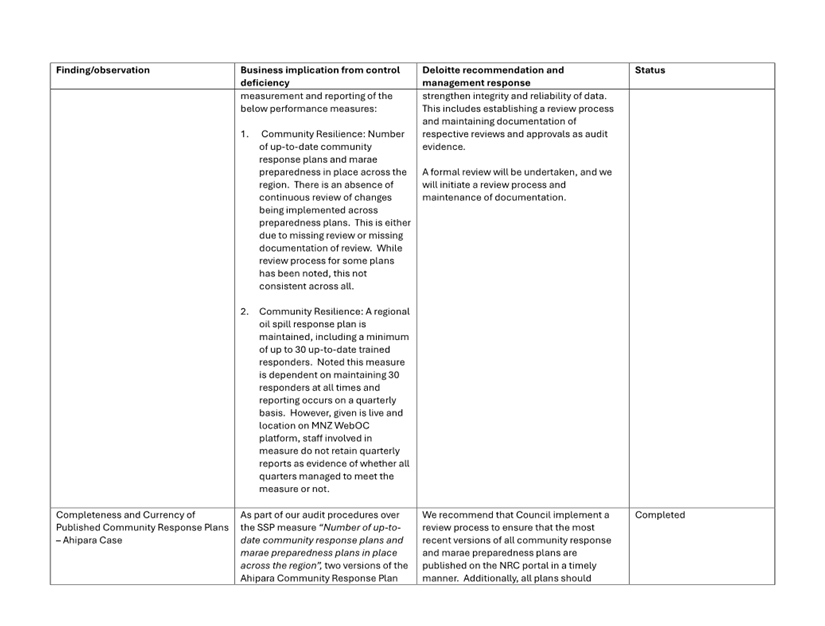

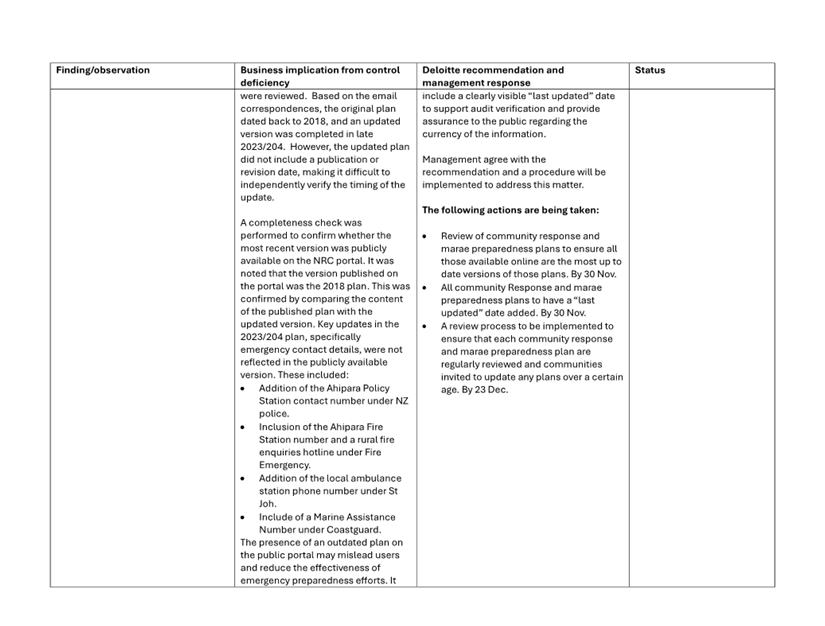

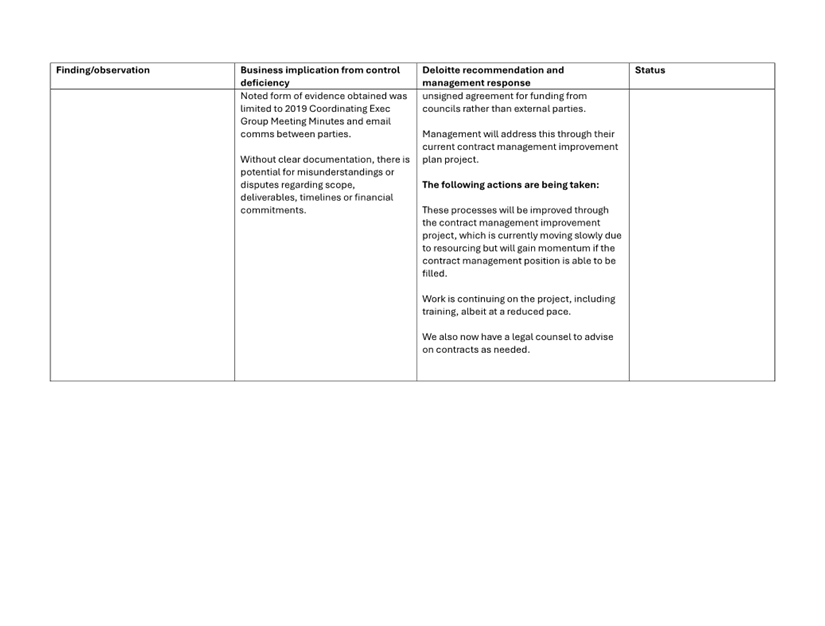

Deloitte Recommendations and Management Response ⇩
Audit and Risk Committee item: 6.1
19 May 2026
|
TITLE: |
Review Terms of Reference |
|
From: |
Margaret Knight, PA to Group Manager Corporate Services |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
Terms of Reference were approved by Council on 25 November 2026, with the resolution stating, ‘That the TOR be reviewed by the respective governance bodies at their first meeting and any agreed amendments be brought back to respective councils for ratification.’ This is an opportunity for the Committee to review the Terms of Reference.
That the report ‘Review Terms of Reference’ by Margaret Knight, PA to Group Manager Corporate Services and dated 4 March 2026, be received.
Background/Tuhinga
Not Relevant
Attachments/Ngā tapirihanga
Attachment 1:

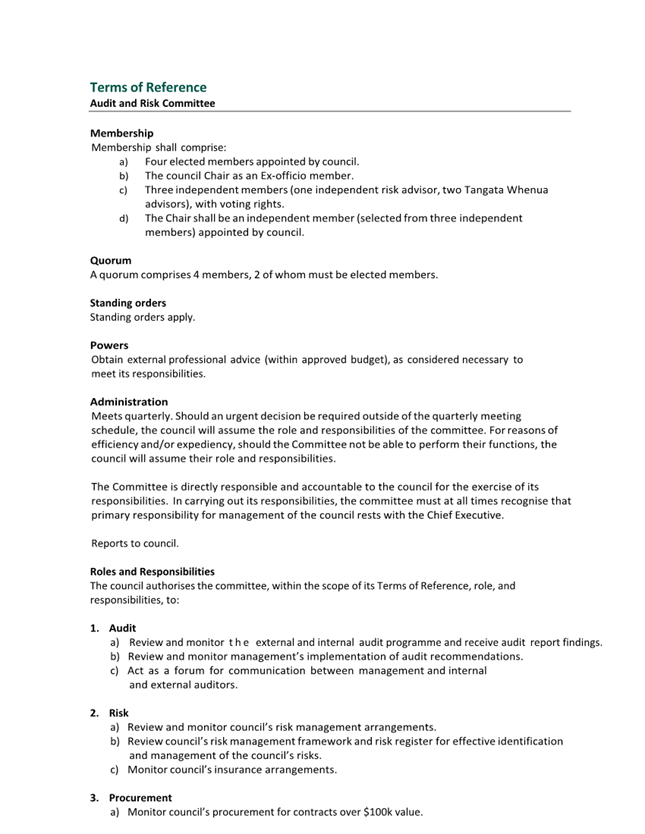

Audit and Risk Committee - TOR ⇩
Audit and Risk Committee item: 6.2
19 May 2026
|
TITLE: |
2025-26 Annual Report: Timetable and Deloitte Planning Report |
|
From: |
Simon Crabb, Finance Manager |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 07 May 2026 |
Whakarāpopototanga / Executive summary

As part of the 2025-26 annual reporting process, council’s external auditors, Deloitte, have prepared a report outlining their planned audit approach, and the key focus areas of their audit. This report is attached as Attachment 1.
The Audit Proposal Letter, which sets out the statutory basis, scope, resourcing, and proposed audit fees is attached as Attachment Two. The proposed fee for the 2026 audit is outlined on page 3 of the letter as $252,492 (GST exclusive). An additional fee of $13,200 will be incurred by council for the assurance engagements relating to the Debenture Trust Deed and Stock Register.
Bennie Greyling of Deloitte (Audit Engagement Partner) will attend the May Audit and Risk Committee meeting to discuss these two attachments and answer any questions.
That the report ‘2025-26 Annual Report: Timetable and Deloitte Planning Report’ by Simon Crabb, Finance Manager and dated 29 April 2026, be received.
Background/Tuhinga

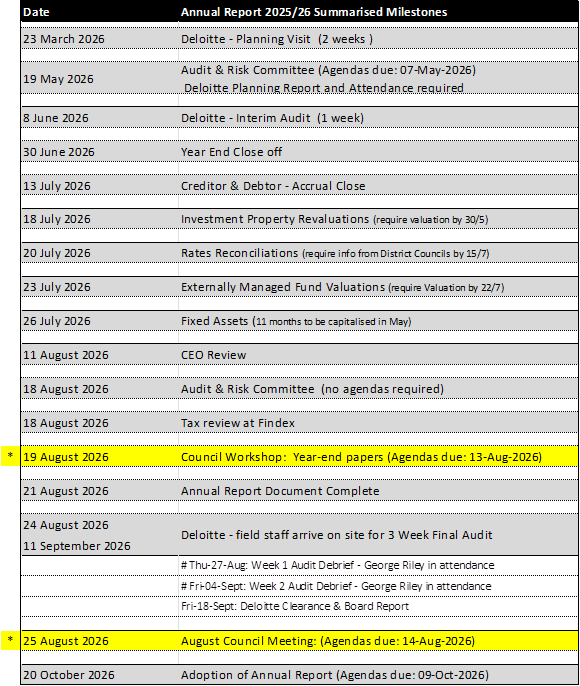

A schedule of the high-level milestone dates for the 2025-26 Audit programme is presented over the page.

# The Chair of the Audit and Risk committee will be involved in weekly debrief meetings with Deloitte throughout the audit programme to oversee progress, understand any emerging issues and report back to this committee if necessary.
* The Council meeting scheduled for 25 August 2026 occurs after the Annual Report is provided to Deloitte on 24 August 2026. As a result, a Council workshop has been scheduled for 19 August 2026 to allow the financial results and associated year end papers to be considered in advance and minimise the risk of changes arising at the 25 August council meeting.
Attachments/Ngā tapirihanga
Attachment 1:

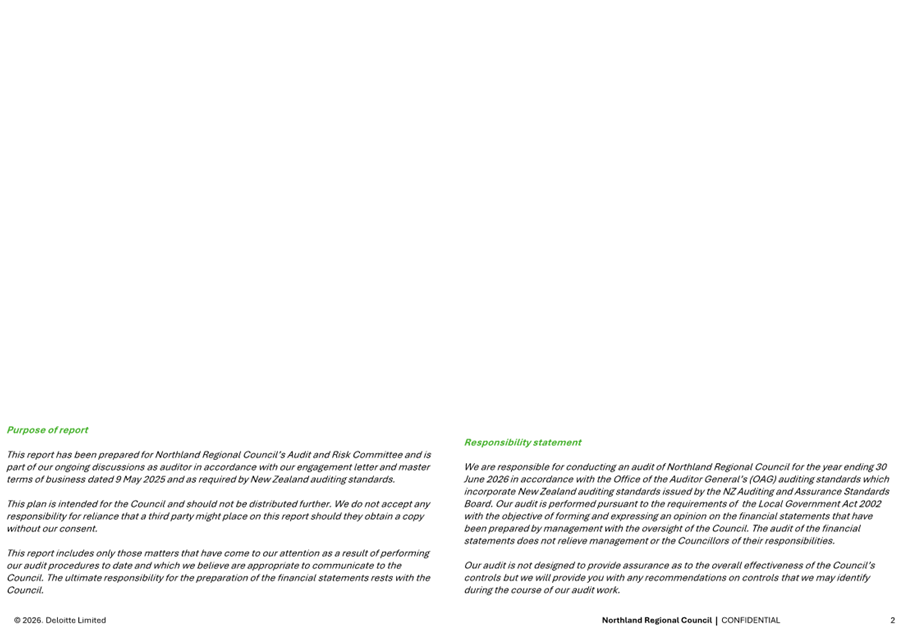

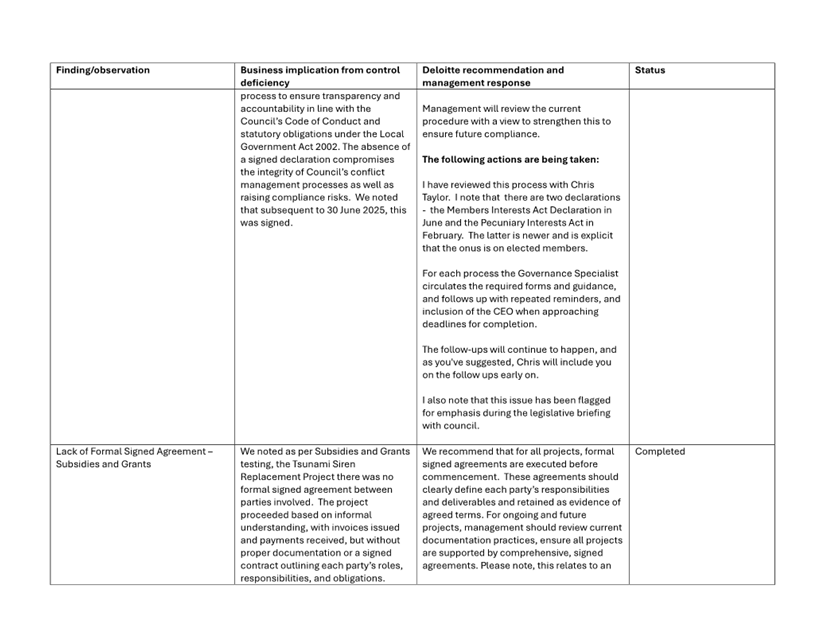

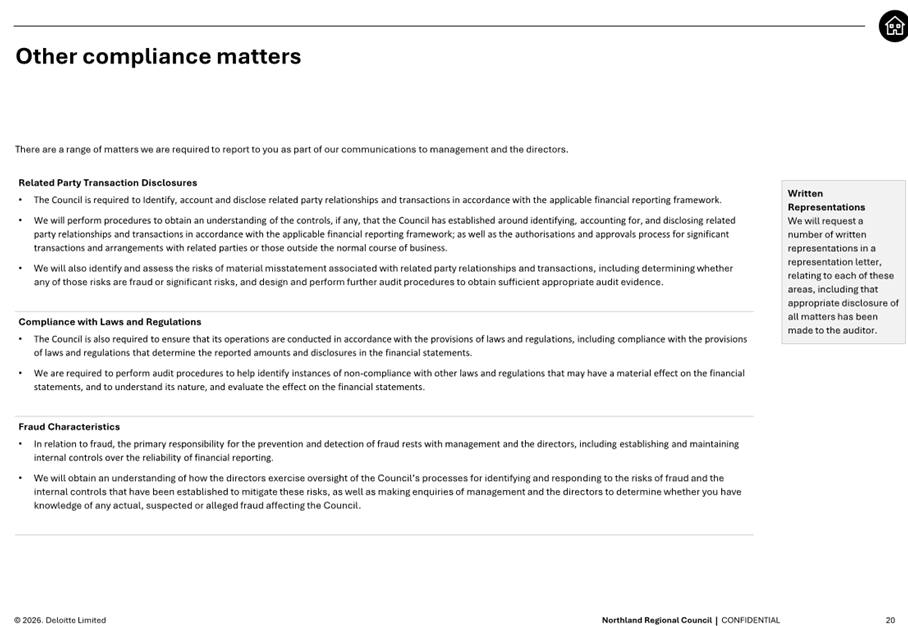

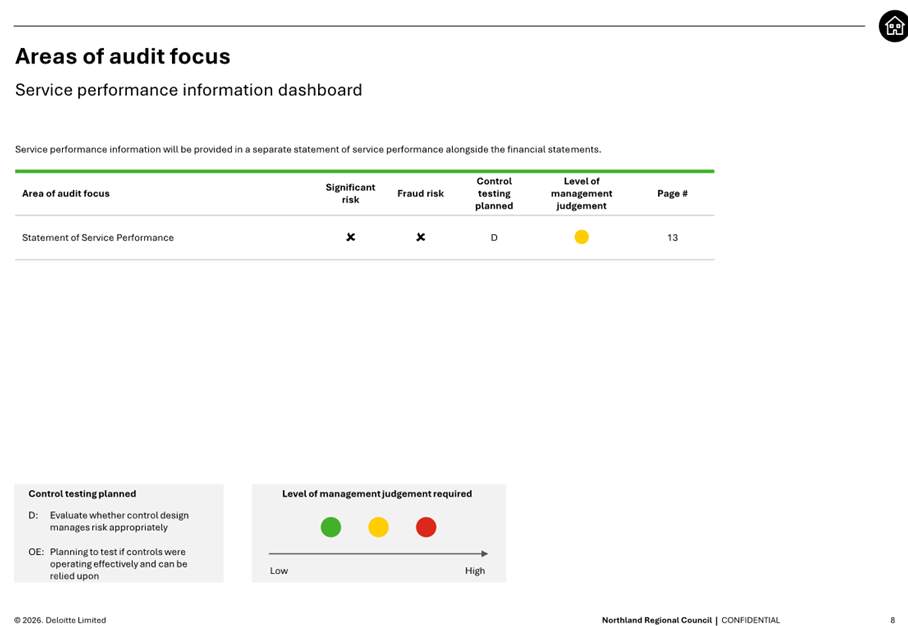

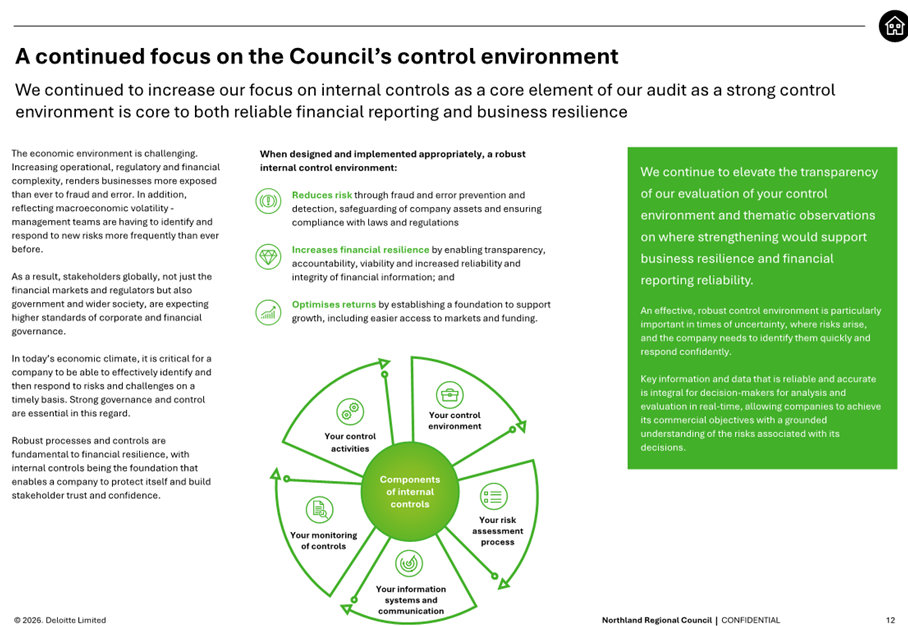

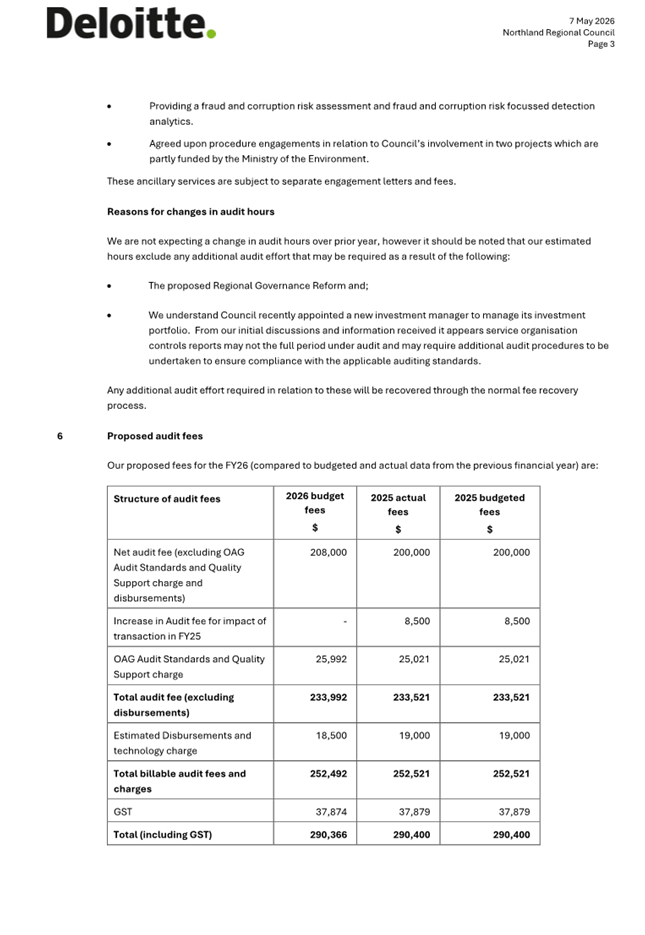

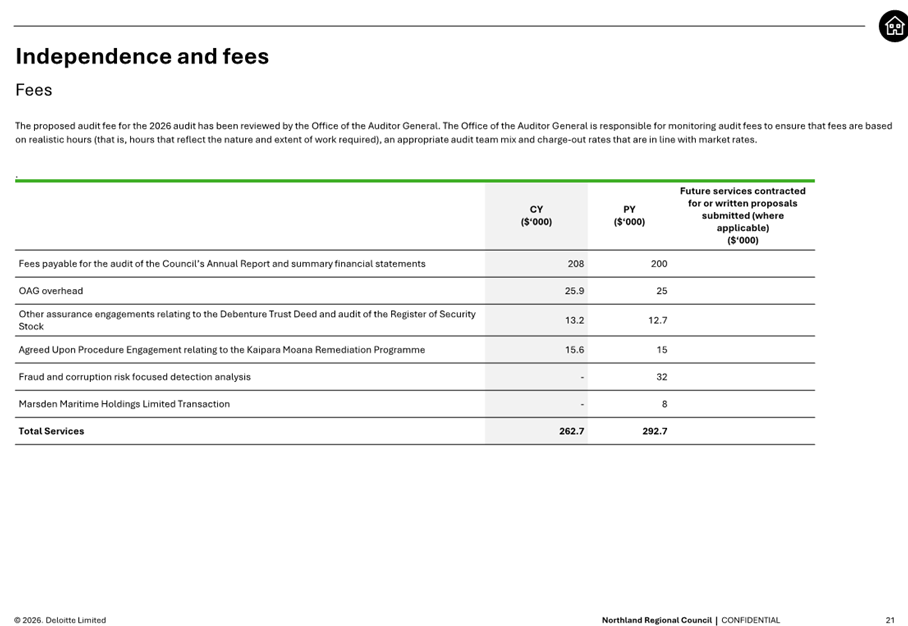

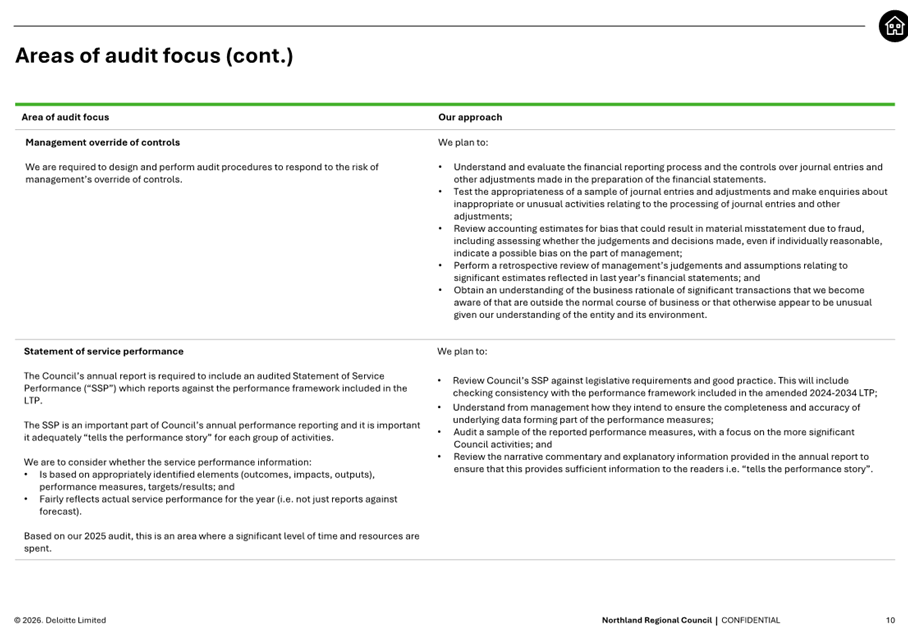

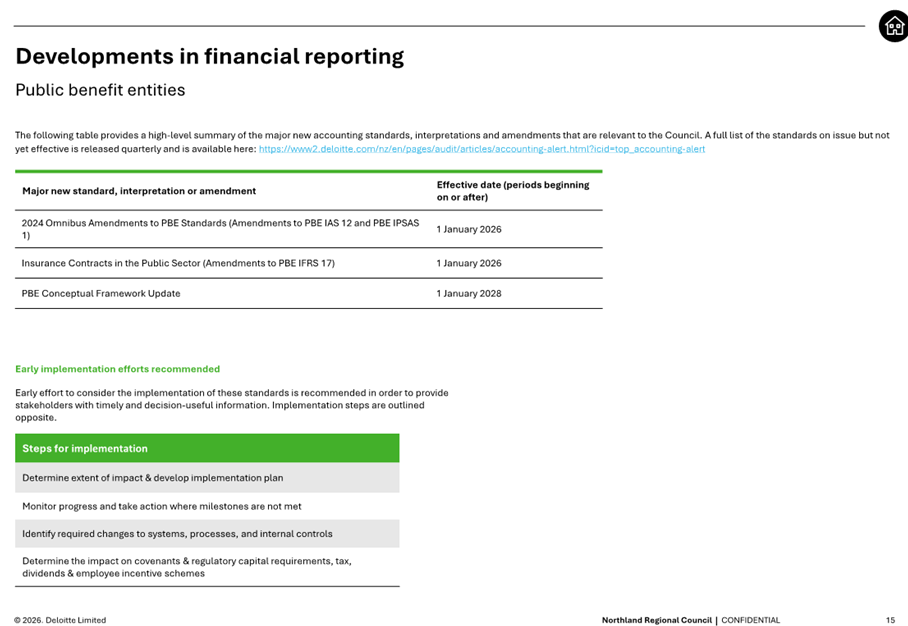

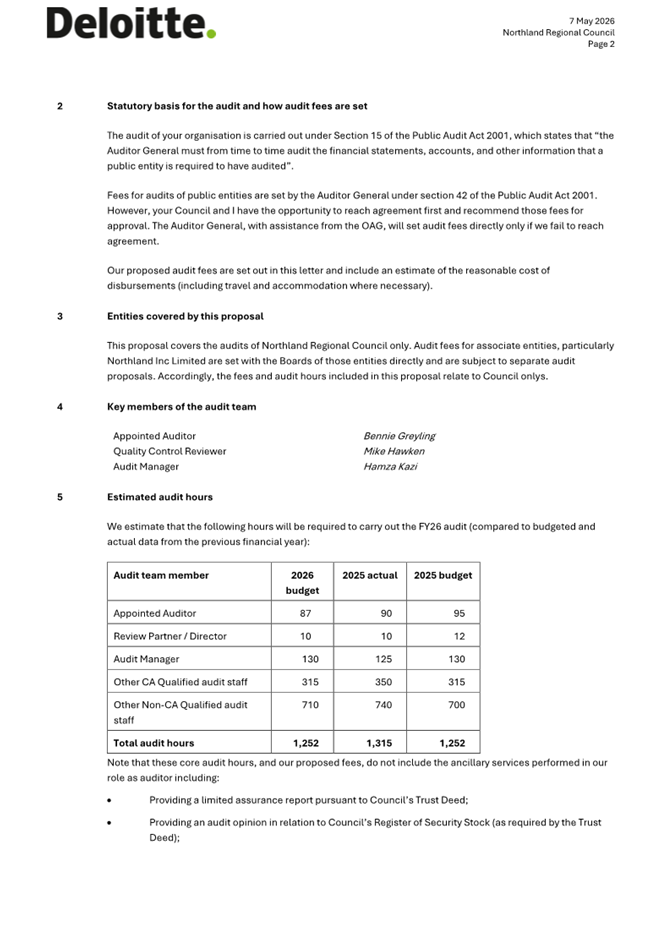

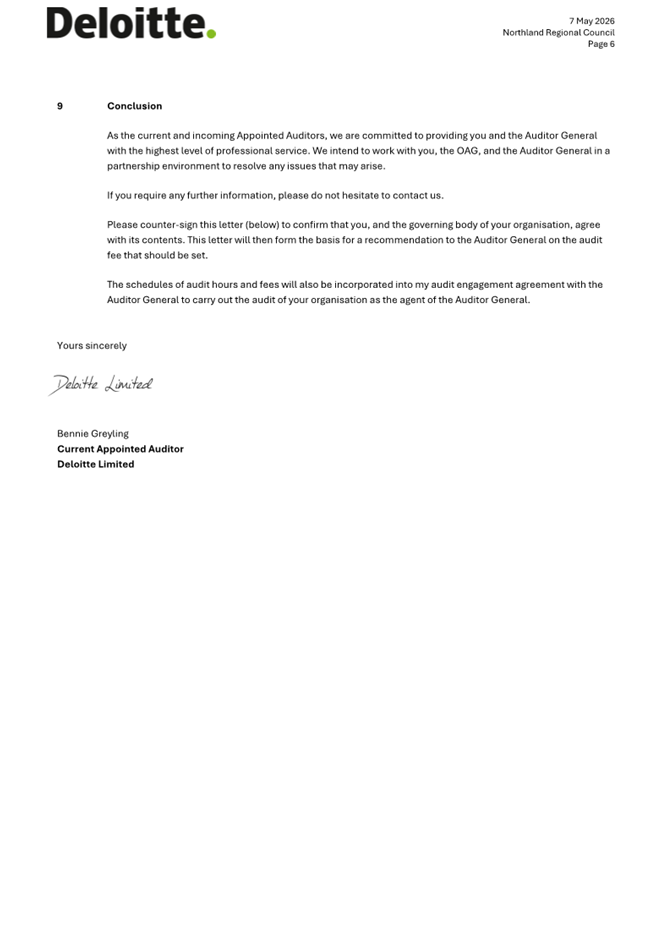

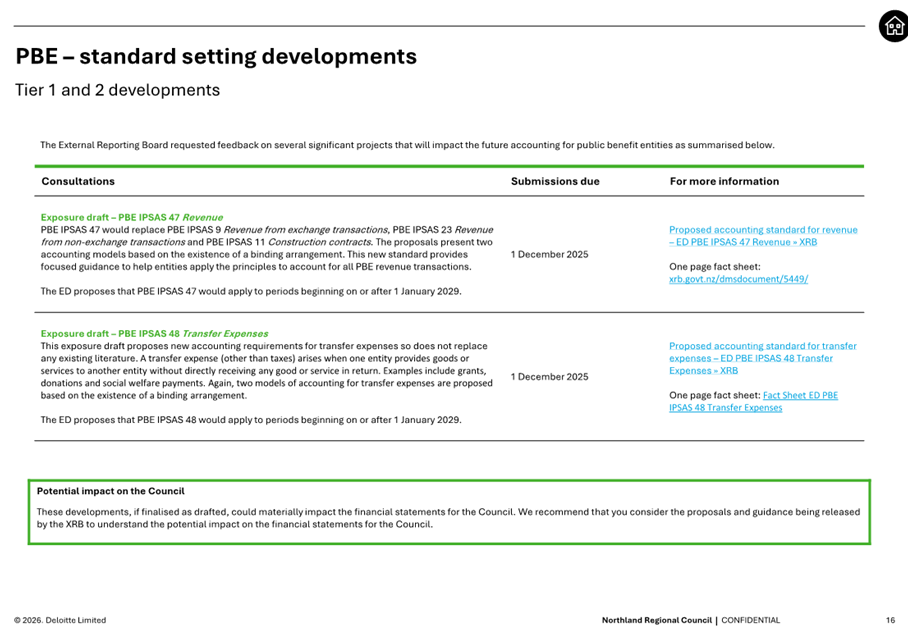

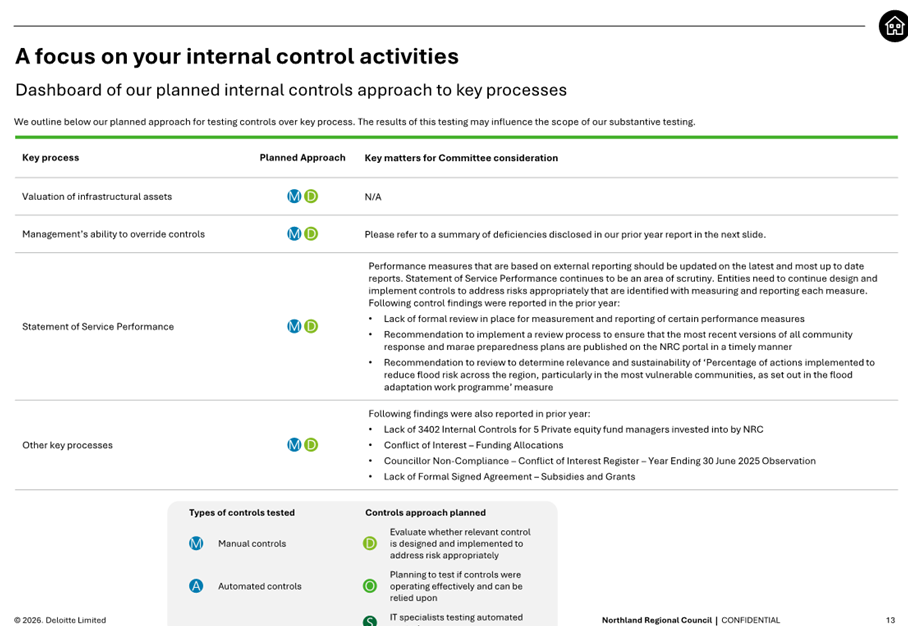

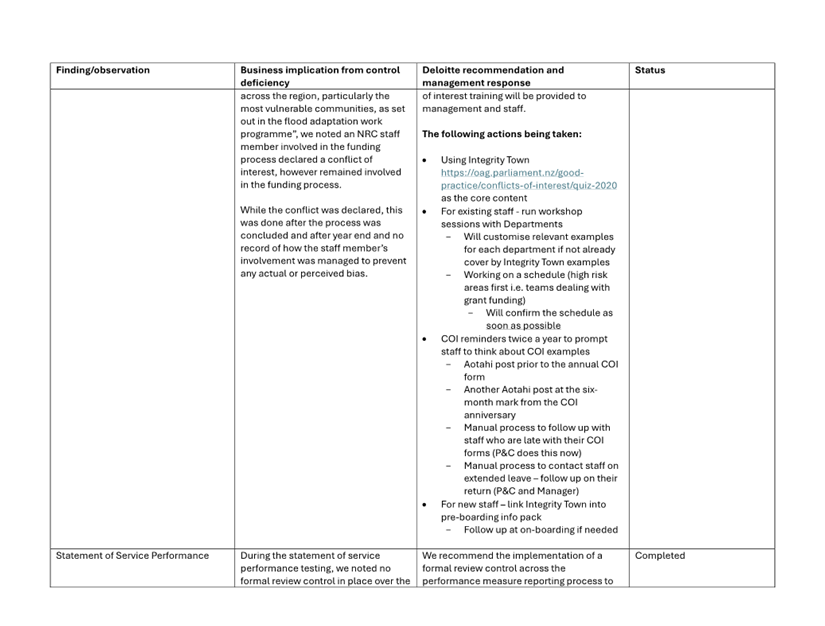

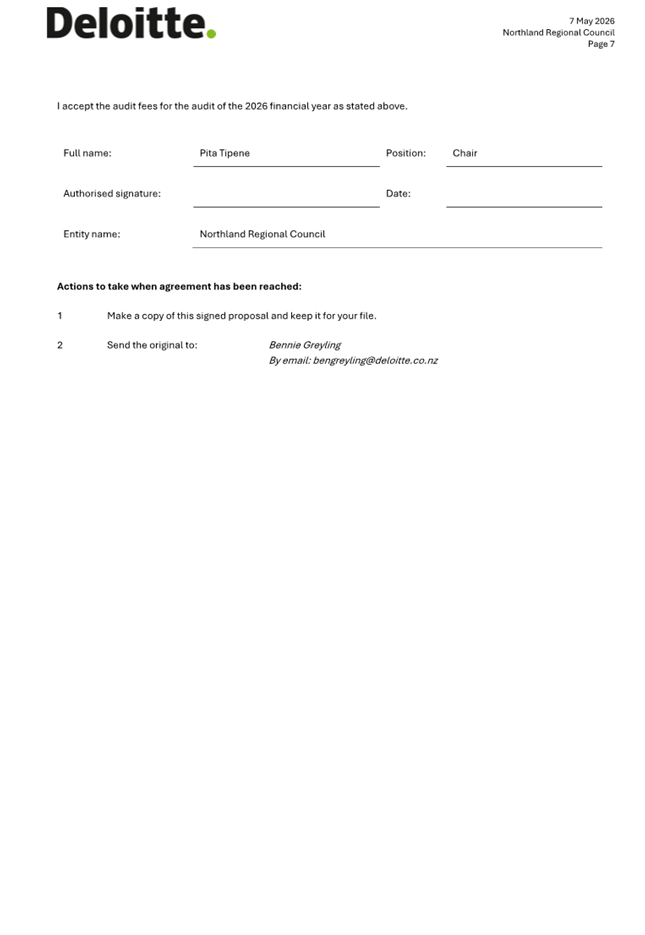

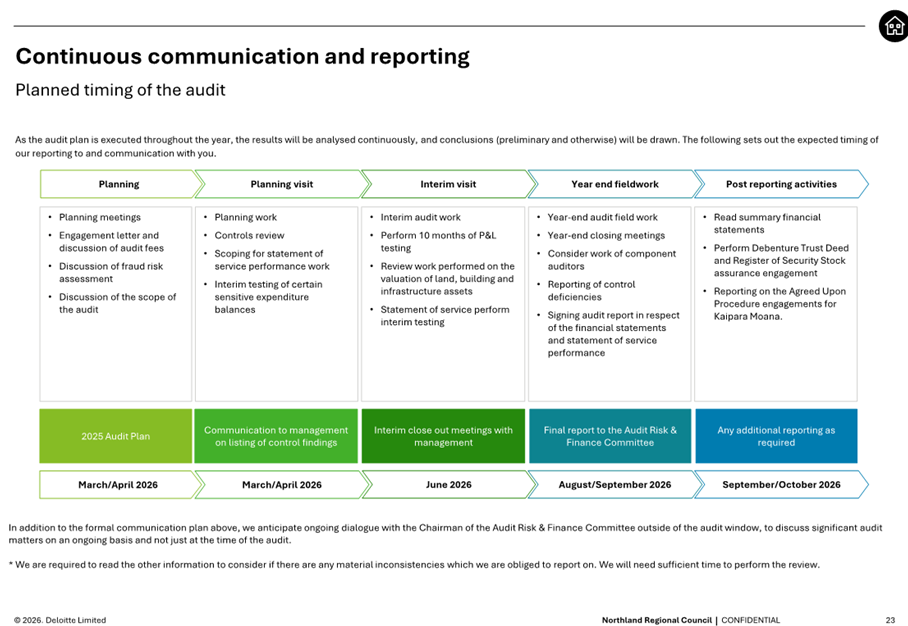

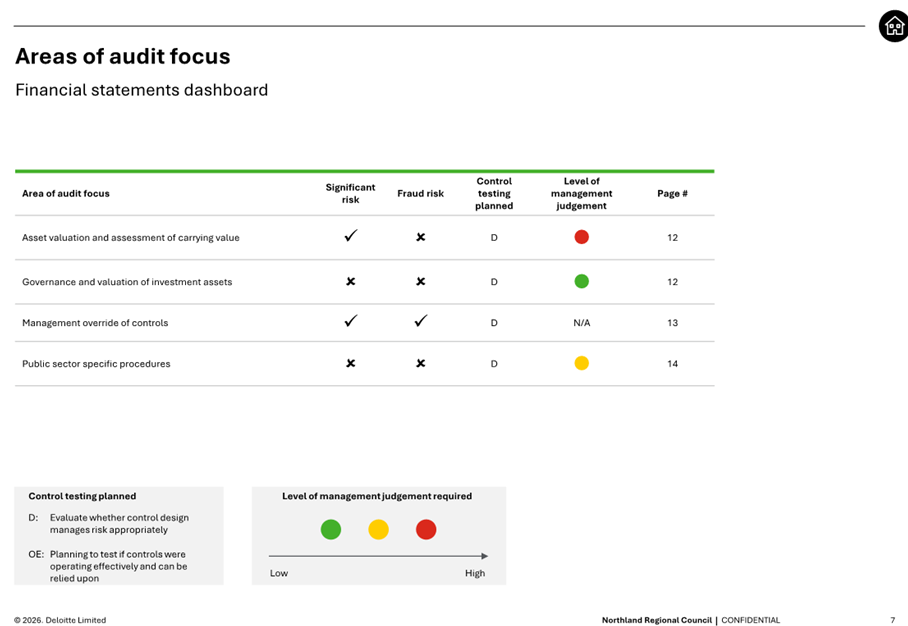

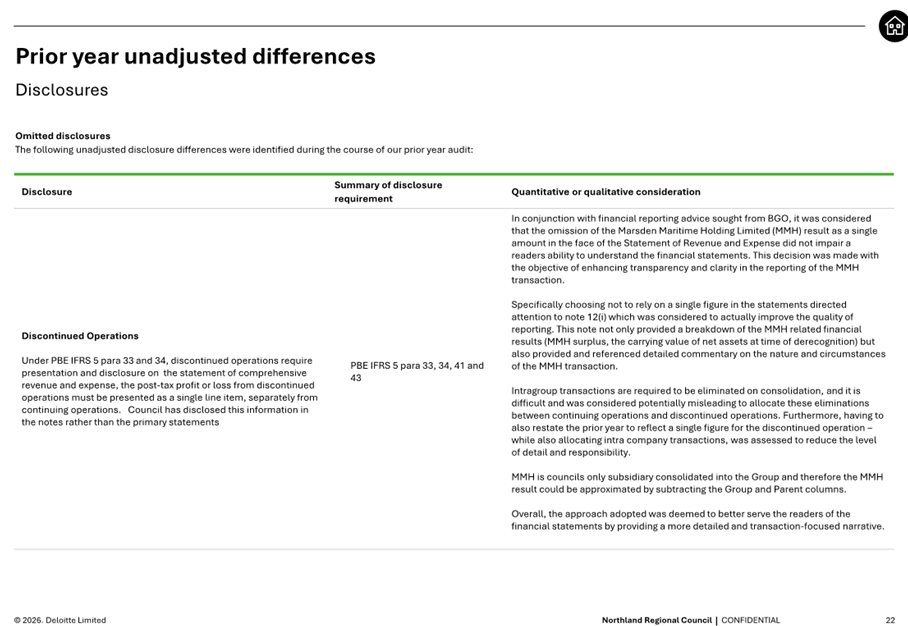

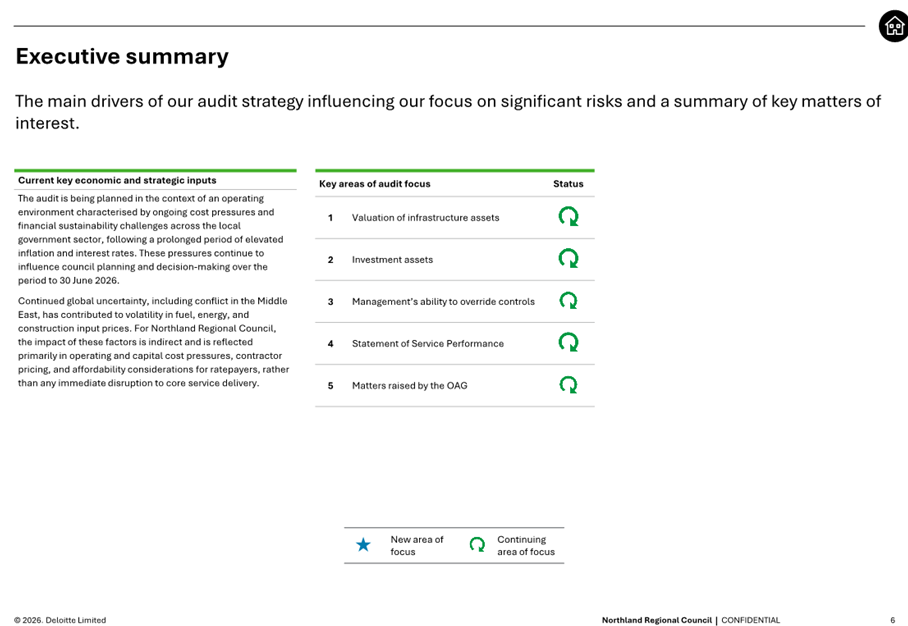

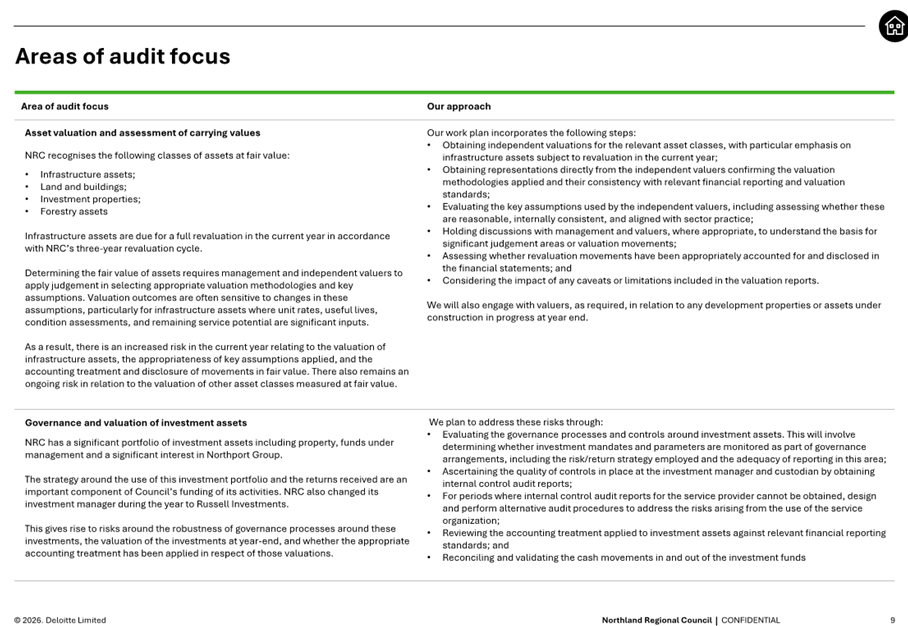

Deloitte Audit Plan for the year ending 30 June 2026 ⇩ ![]()
Attachment 2:

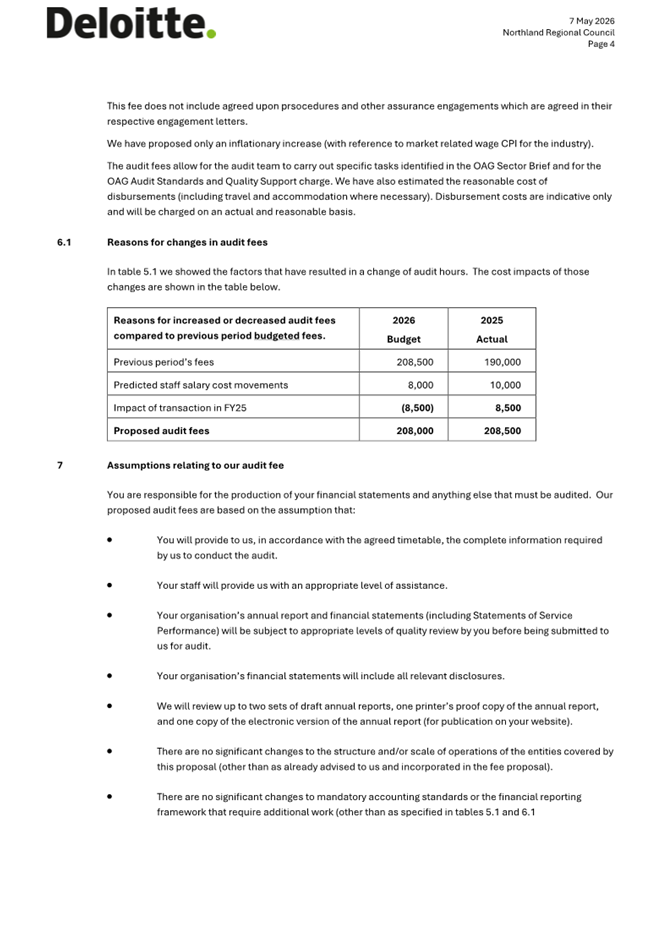

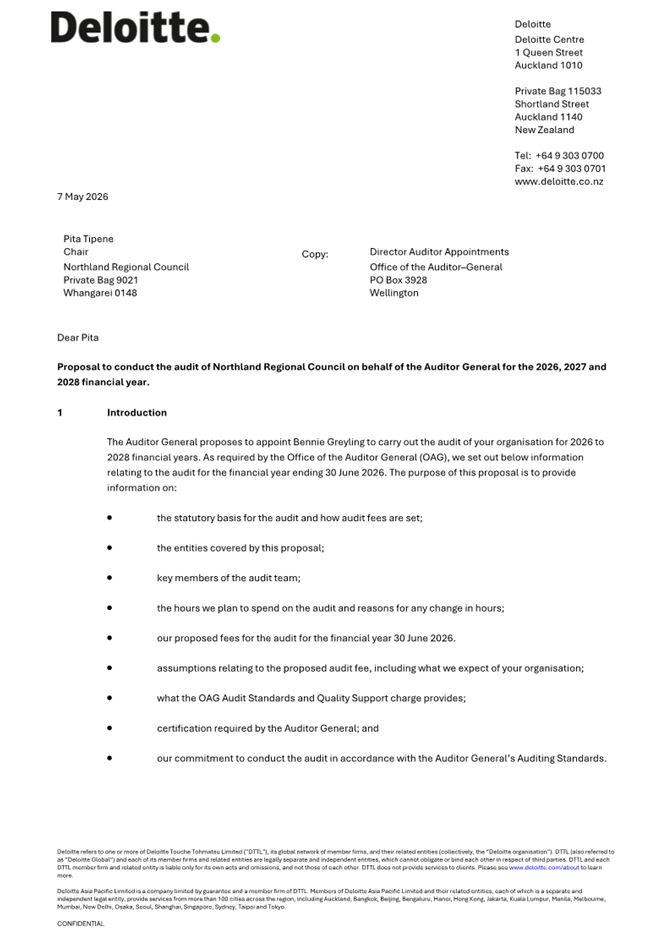

Audit Proposal Letter for the 2026, 2027 and 2028 financial years ⇩
Audit and Risk Committee item: 6.3
19 May 2026
|
TITLE: |
Financial Report April 2026 |
|
From: |
Taka Skipwith, Financial Accountant |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 13 May 2026 |
Executive summary/Whakarāpopototanga

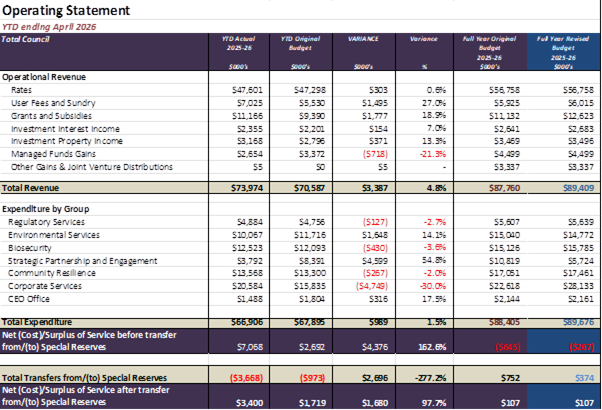

This report details the year to date (YTD) financial results

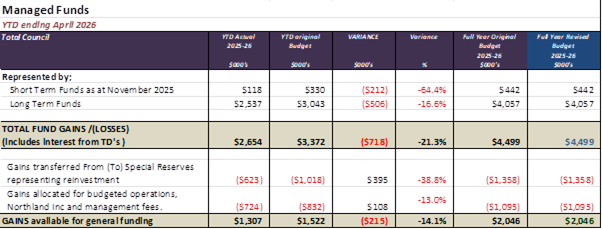

for April 2026. The council has achieved a YTD surplus of $3.40m after
transfers to and from reserves, which represents a favourable variance of
$1.68m compared to the original budgeted of $1.72m. All comparisons in
this report are based on the original budget.
This report also proposes 2025-26 Year-End Surplus Apportionment
Framework. Table 7 presents a proposed framework for the allocation of
any year-end operating surplus (noting this excludes any council decision to
utilise a portion of the surplus prior to the end of the fiscal year).
1. That the report ‘Financial Report April 2026’ by Taka Skipwith, Financial Accountant and dated 13 May 2026, be received.
2. That the Committee recommends to council the framework outlined in Table 7, to guide the allocation of any year-end operational surplus and surplus investment fund returns for the 2025-26 financial year.
Options
|
No. |
Option |
Advantages |
Disadvantages |
|
1 |
The Committee recommends to council the surplus allocation framework outlined in Table 7. |
The framework supports consistent treatment and reporting of any surpluses aligned with councillor expectations. A pre-defined approach allows council to align surplus allocation decisions with long-term priorities (e.g. debt reduction) rather than making any ad hoc decisions at year-end. |
A pre-defined framework may become outdated if council priorities change or new opportunities emerge between now and year end.
|
|
2 |
The Committee declines to support the proposed surplus allocation framework outlined in Table 7. |
Improves council’s ability to respond to any unforeseen circumstances at year-end through specific decisions, although this may reduce the overall discipline and consistency provided by the framework. |
May increases the likelihood of ad hoc decision-making and project-by-project debate, reducing consistency in how surpluses are allocated and weakening the discipline intended under the framework. |
The staff’s recommended option is Option 1
Considerations
1. Alignment to council strategic direction - community outcomes
The matters covered in this report relate to the following community outcomes:
|
☐ Carbon neutral, resilient communities in a changing climate |
|
|
☒ Efficient, progressive and transparent council systems
|
|
2. Climate Impact
Being a purely administrative matter, any decisions arising from this report will not have any climate change implications.
3. Environmental Impact
Being a purely administrative matter, any decisions arising from this report will not have any environmental impact.
4. Community views
The proposed framework in Table 7 is an administrative mechanism to govern the allocation of any year-end surpluses and does not in itself result in any direct impact on the community.
5. Māori impact statement
There are no known impacts on Māori which are different to the general community in relation to this decision.
6. Financial implications
The proposed framework in Table 7 is administrative mechanism and does not in itself have any direct financial impact. It provides a structured approach to the allocation of any year-end operational surpluses and surplus investment returns. The quantum and financial impact will depend on the actual year-end results.
7. Implementation issues
Staff do not anticipate any implementation issues with the application of the proposed framework in Table 7.
8. Significance and engagement
In relation to Section 79 of the Local Government Act 2002, this decision is considered to be of low significance when assessed against council’s Significance and Engagement policy because it is part of council’s day-to-day activities. This does not mean that this matter is not of significance to tangata whenua and/or individual communities, but that council is able to make decisions relating to this matter without undertaking further consultation or engagement.
9. Policy, risk management and legislative compliance
There are no significant legislative compliance issues arising from the adoption of the proposed framework in Table 7. The proposed framework is consistent with council’s financial management approach and supports prudent risk management by reducing the likelihood of ad hoc decision-making and ensuring surplus allocations are aligned with agreed priorities.
Background/Tuhinga
1. The operating surplus, before transfers to and from reserves, for the YTD period ending April 2026 is $7.07m, which exceeds the original budget of $2.70m, by $4.38m (refer to Table 1). The operating surplus after transfers to and from reserves is $3.40m, representing a favourable variance of $1.68m compared to the original budgeted of $1.72m.
Table 1
The contributing factors for the YTD favourable variance are:

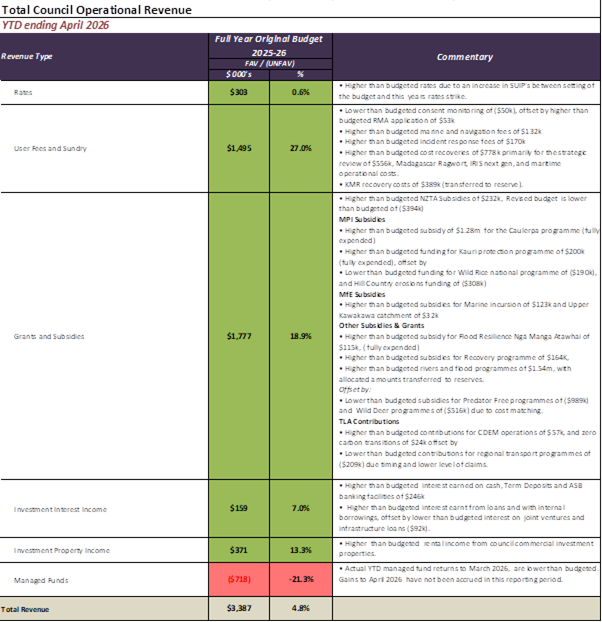

YTD Operating Revenue (table 4) favourable variance of $3.39m is 4.8% of the budget and predominantly due to:
· MPI subsidies for Biosecurity response programmes are $1.29m higher than planned, and Crown Infrastructure subsidies for rivers and flood mitigation programmes are $1.54m above budget; any unallocated subsidies will be transferred to special reserves or deferred for future cost matching.
· Higher than planned cost recovery of $1.17m for the strategic review, KMR and other council programmes.
· Managed fund returns softened in March amid market volatility; July 2025–March 2026 results are 59% of the full-year budget.

o Fund performance YTD is $2.65m against a YTD budget of $3.37m, resulting in a YTD unfavourable variance of ($718k) (Refer to Table3)
o Fund gains have been allocated to reinvestment in council reserves, CCO and community support, and management fees to the amount of $1.34m. $1.31m is therefore allocated to councils’ general operations.
YTD Operational Expenditure (table 5) favourable variance of $989k which is 1.5% of the budget, due to:
· Salary savings across council of $1.24m based on the original budget; reduced by the allocation of additional salaries redirect approved during this financial year of $591k.
· Council wide expenditure variances as detailed in Table 5.

Net Salary savings across council for the YTD is $654k; represented by $1.24m of redirected salary savings, reduced by the allocation of additional redirection of salaries savings as approved of $591k refer to Table 2. During the month of April, the redirection of $78k from salary savings was approved for the cyclone Vaianu response, of which $5k has been expended.
Table 2

Reserve Movements (Table 6) variance of $2.70m arises from net transfers to reserves of $3.67m compared to a budgeted net transfer to reserves of $973k. The variance is due mainly to.
· Higher than budgeted transferred to the Regional Project Reserve, and the Economic Development Reserve (IIFR)
· Higher than budgeted transfers to the Flood Infrastructure Reserve for a multiple flood mitigation and programme of works
· Additional reserves movements listed in table 6.
Capital Expenditure
Capital expenditure YTD is $7.22m and is $3.20m lower than the corresponding budget of $12.8m in April. This is due to
· Flood infrastructure and river projects progressing ahead of budget by ($4.37m), being partially funded by Crown Infrastructure Partnerships. Offset by
· The design and build of the Joint emergency co-ordination centre is $4.09m behind the original budget. The centre development and remaining budget will be deferred to next financial year.
· The Hannah Street Redevelopment YTD budget of $2.4m remains unspent due to the decision not to proceed with the redevelopment.
· Council vehicle replacement programmes of $613k, being behind the planned budget. The vehicles have been ordered or are at various stages of being equipped for council use.
Table 3

Table
4
Audit and Risk Committee item: 6.3
19 May 2026
The impact of the restructure of economic development, community representation programmes and emergency services grants are.
*Corporate Services: Of the ($4.75m) unfavourable variance, ($4.43m) or (93%) is attributable to restructuring-related expenditure across group. Excluding the impact of the restructure the revised group variance would be ($317k) unfavourable.

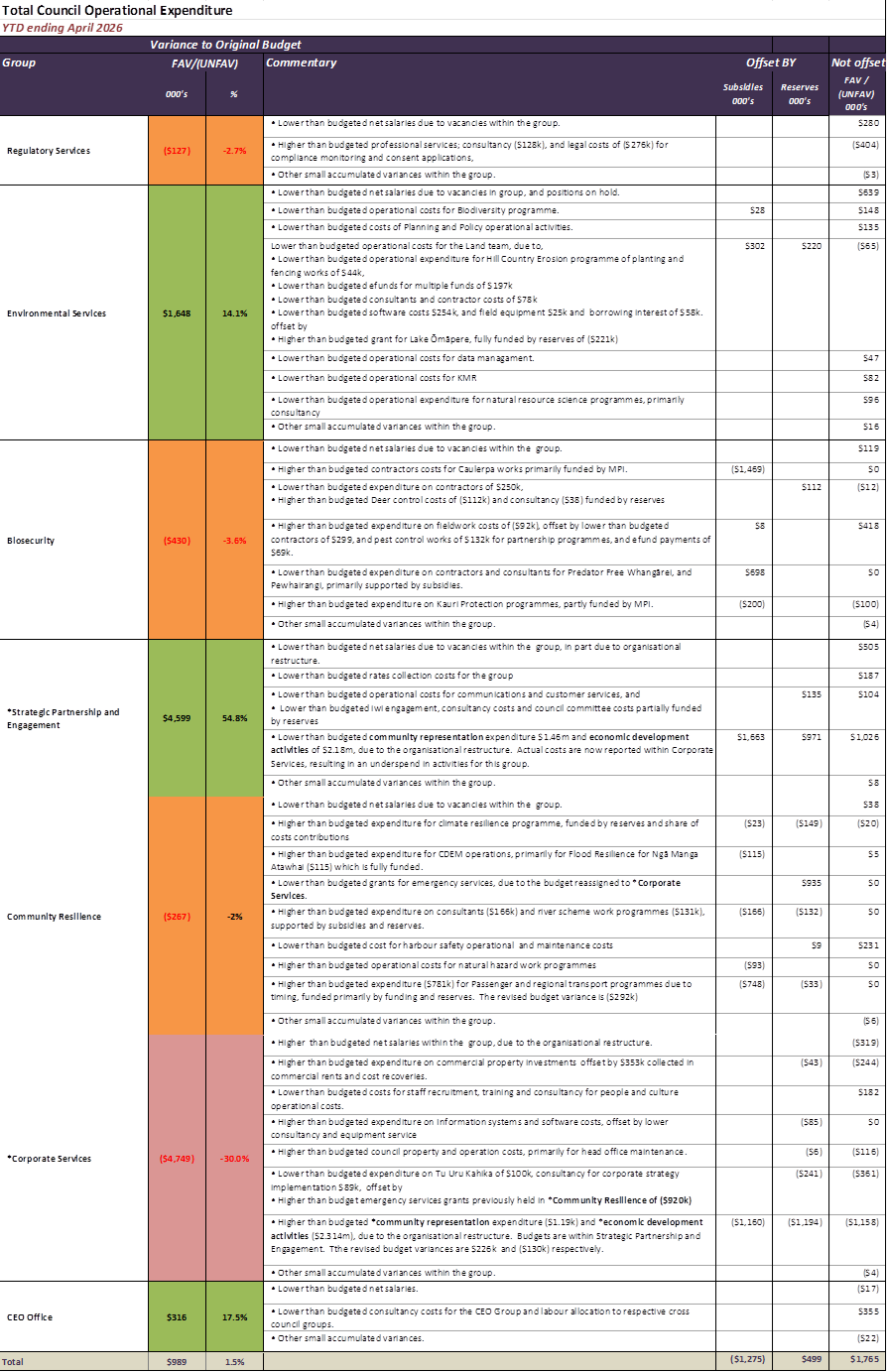

*Strategic Partnership & Engagement: Of the $4.60m favourable variance, $3.66m (representing 80%) is attributable to restructuring-related expenditure across groups. Excluding the impact of the restructure the revised group variance would be $939k favourable.
Table 6

2. Proposed 2025-26 Year-End Surplus Apportionment Framework
The purpose of this framework is to establish an agreed approach to surplus allocation that staff can apply in the preparation of the year-end financial reports. The amounts shown in each step of Table 7 are illustrative only and are expected to change by year-end.

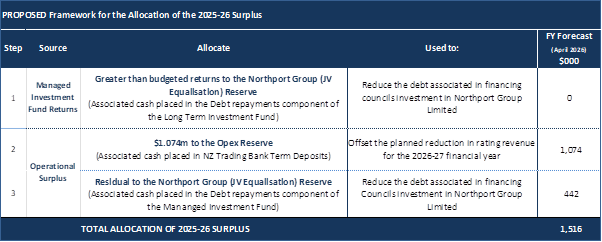

Table 7

Attachments/Ngā tapirihanga
Nil
Audit and Risk Committee item: 6.4
19 May 2026
|
TITLE: |
Risk Management Activity Update |
|
From: |
Mandy Tepania, Audit and Assurance Lead |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
The Risk Management Activity Update Report outlines the summary of the Council’s progress in risk
management related activities including Strategic and Operational.
That the report ‘Risk Management Activity Update’ by Mandy Tepania, Audit and Assurance Lead and dated 8 May 2026, be received.
Background/Tuhinga
Risk can be simply defined as “The effect of uncertainty on objectives”; Risk management is the assessment of this uncertainty, and encompasses both the likelihood of something happening, and the consequences or impacts if it were to happen, which can introduce both opportunity and hazards.
The council has recently implemented a new risk management tool called ‘WayPoint’. The risk register in Waypoint provides an opportunity to capture Strategic, Operational, Programme and Project risks providing visibility for better management and overview at all levels.
Strategic Risks
Risks become strategic in nature (as opposed to operational) where the risk widely impacts the whole organisation, as opposed to limited department. These risks are significant because they impact on the ability of the council to deliver against the Long-Term Plan (LTP). LTP holds the council accountable for their activities and long-term focus.
Operational Group Risks
An operational risk presents a potential impact on the council’s individual groups achieving their objectives. Operational group risks are identified and managed by group managers and their teams. Group risk must be regularly reviewed and reported as evidence of management. The introduction of the ‘WayPoint’ tool, along with training on its use and clear expectations, has enhanced the ability to provide regular updates, conduct reviews, and improve visibility in identifying areas of concern.
Risk Management Matrix Evaluation Tool (to explain the ranking against each risk)
|
Likelihood |
Consequence |
||||||
|
Inconsequential (1) |
Minor (2) |
Moderate (3) |
Major (4) |
Severe (5) |
|||
|
Frequent (5) |
5 Moderate |
10 High |
15 Extreme |
20 Extreme |
25 Extreme |
||
|
Often (4) |
4 Low |
8 High |
12 High |
16 Extreme |
20 Extreme |
||
|
Likely (3) |
3 Low |
6 Moderate |
9 High |
12 High |
15 Extreme |
||
|
Possible (2) |
2 Low |
4 Low |
6 Moderate |
8 High |
10 High |
||
|
Rare (1) |
1 Low |
2 Low |
3 Low |
4 Low |
5 Moderate |
||
Progress on risk management since the last meeting of the Audit, Risk and Finance Subcommittee includes:
1. The Strategic and Operational group risk registers have been refreshed following leadership review.
2. Staff have managed the identified risks and their corresponding mitigation actions (controls) using the risk module in WayPoint.
The tables and attachments below provide details for:
· Table 1 provides a brief overview of risks that have been updated/ added over the past quarter.
· Table 2 outlines the risks rated high or above for Strategic/Corporate services.
· Table 3 outlines the risks rated high or above for Operational services.
· Deep Dive Schedule is summarised in Table 4.

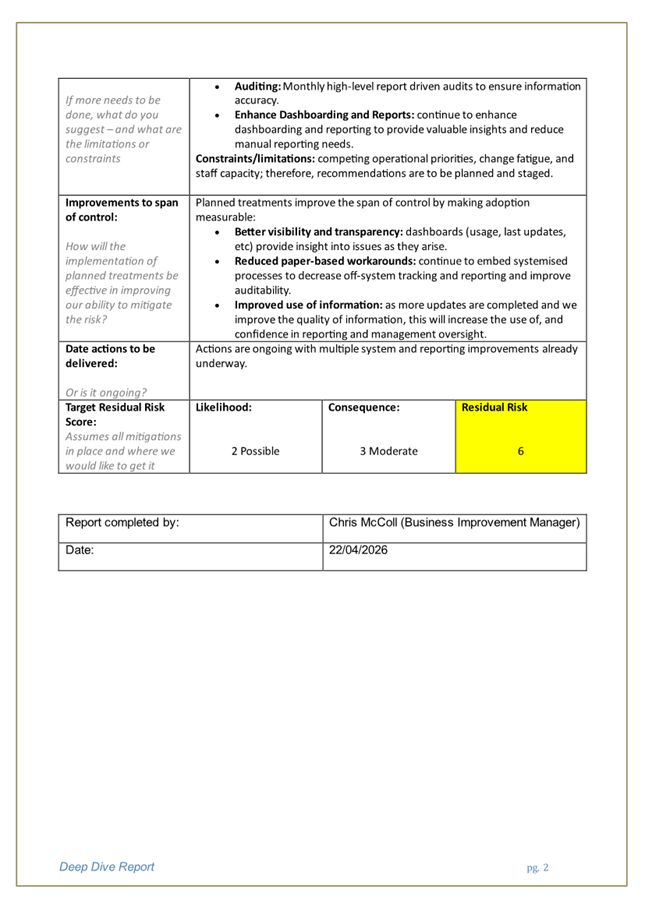

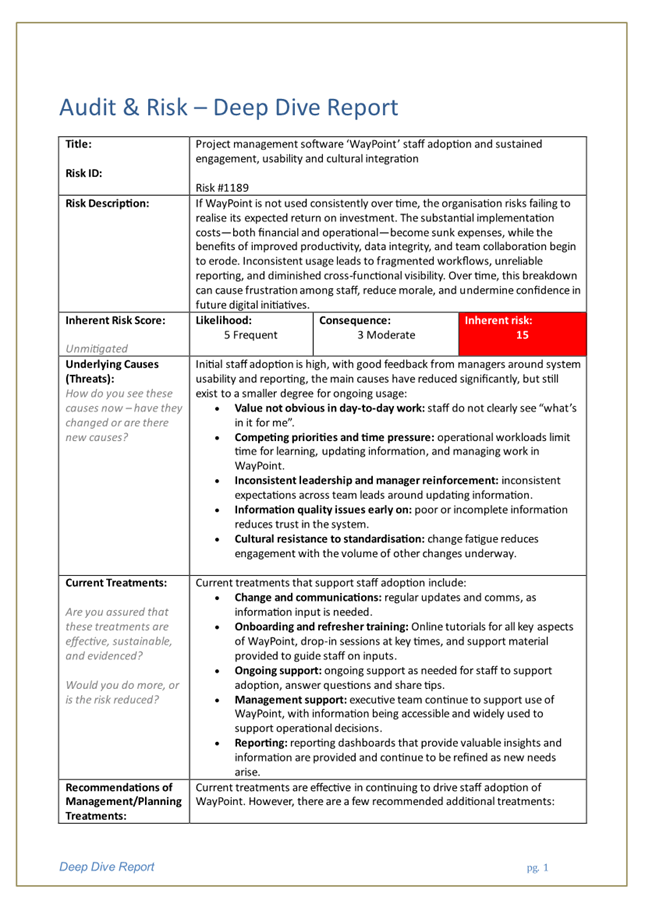

· Deep Dive Report – Risk 1189 Project management software ‘WayPoint’- Staff adoption and sustained engagement, usability and cultural integration. – Attachment 1.
|
Risk Title |
|
|
#1069 |
Local Government Structural Reform – Impact on regional governance and outcomes |
|
|
Updated Activity: Trending â |
|
Strategic Services |
There is a risk that the Government's fast-tracked local government reform programme results in the integration of regional councils into new unitary authorities in a manner that weakens region-wide governance, dilutes environmental and catchment-scale outcomes, and reduces strategic oversight of long-term regional priorities. This may occur if regional council functions are consolidated without sufficient influence from regional entities, leading to decisions being dominated by local service and growth pressures rather than integrated regional and environmental considerations. A Council led programme is in the early stages of implementation and includes participation from District Councils within the Northland region. ‘Northland Local Government Reform Programme (By Northland for Northland)’ Inherent Risk 16 often/major Residual rating 6 possible/moderate |
|
#1189 |
Staff adoption and sustained engagement, usability and cultural integration with the Project management software (WayPoint) |
|
|
Risk Update: Trend â |
|
Strategic Risk |
Actions are ongoing with multiple system and reporting improvements already underway. Regular reporting allows visibility of training requirements and ongoing support therefore a reduction in residual rating has been applied. Inherent rate - frequent/moderate 15 Residual rate - likely/moderate 6 |
|
#1010
|
Changes in legislation & central Government policy impacting council's resources, budgets and activities. |
|
|
Risk Update: Retired - replace with new Risks #1069 and #1295 |
|
Strategic Risk |
In light of the Government’s accelerated local government structural reform announcement earlier this week, and the separation of RMA and planning system reform, Risk #1010 no longer appropriately reflects the current reform environment. Accordingly, this risk has been retired, and separate, more targeted risks are being developed.
|
|
#1052 |
Gold Clam Biosecurity Response |
|
|
Risk Update: Static |
|
|
Investigating potential wash station locations with private landowners and Kaipara District Council to reduce the risk of Gold Clam. While this work is undertaken the residual risk remains static. Inherent risk rating 20 (frequent/severe) Residual risk rating 10 (possible/severe) |
|
#1108 |
Core IT applications/Systems are not designed and/or implemented to support all organisational processes, or applications will stop working |
|
|
Risk Update: Static |
|
Strategic Risk |
· HCM and Asset systems are being replaced, with both projects on track for completion by July 2026. · Business SME's are heavily involved and engaged to ensure the systems are configured to support organisational processes. · The process for triaging new service desk 'project' is being reviewed to ensure a consistent methodology is used to evaluate requests and license and support costs are actively considered. · The new Project and Risk Management system (Waypoint) is now operational. · CRM system will be implemented as part of the IRIS NG product (Datascape). · A Middleware Integration platform is being selected to automate the transfer and maintenance of key data between core systems to avoid data anomalies and duplication of effort. Some servers running older operating and SQL versions are being updated to ensure all systems are running on current or supported versions. Inherent risk rating 20 Frequent/Major Residual risk rating remains at 6 Possible/Moderate |
|
#1294 |
Fuel Supply Disruption Business Continuity (BCP) Risk Planning |
|
|
Risk Update: New |
|
Operational Risk |
There is a risk that a minor, moderate, major, or prolonged disruption to fuel supply will reduce staff mobility and constrain fleet operations and generator refuelling, resulting in Northland Regional Council being unable to maintain essential services and deliver critical regional services. Inherent risk rating 9 Likely/moderate Residual rating 6 likely/minor |
|
#1295 |
Resource Management Reform |
|
|
Risk Update: New |
|
Strategic Risk |
Failure to effectively transition to the new resource management system caused by compressed legislative timeframes, limited specialist capacity across the four Northland councils, evolving national direction, and reliance on cross-council coordination, resulting in failure to meet statutory deadlines, fragmented regional planning outcomes and inability to provide for Māori participation as required under the reform legislation. Inherent risk rating 16 often/major Residual risk rating 6 possible/moderate |
Table 1. Strategic risks listed -rating high and above
|
Extreme |
High |
Moderate |
Low |
|
|
Key – Trend |
Increasing (I) |
Decreasing (D) |
New (N) |
Static (S) |
|
# |
Risk Statement |
Inherent Rating |
Residual Rating |
Trend |
|
1 #1003 |
IRIS Next Gen Programme Delivery |
12 |
8 |
S ↔ |
|
Status Update |
Sector Programme- The planned Otago Regional Council design workshops for the Pilot are currently on hold until the software is fully functional and outstanding system issues are resolved. Any potential delays to the timeline are yet to be confirmed, and the programme‑wide impacts are still being assessed. NRC continues to support the ORC Pilot by contributing expertise to progress work that can continue during this pause.
NRC Project - Work continues to focus on understanding how the current Classic IRIS system is used, enabling a comprehensive current‑state view of system business functions. This will help determine consistency, extent of use, and examples of good practice. Where opportunities arise, early transition planning is being explored to reduce effort and complexity ahead of NRC’s implementation date. The current‑state assessment will also be compared to the future‑state design to inform the scope of change required. |
|||
|
2 #1041 |
Inefficient Contract Management programme available to meet the contractual need of NRC |
15 |
12 |
S ↔ |
|
Status Update |
Investigation of software options has been brought forward and it currently underway. |
|||
|
3 #1000 |
External and internal pressures impacting work programme delivery (previously called workload) |
15 |
9 |
S ↔ |
|
Status update |
Risk remains unchanged. Further work being investigated around programme management combined with core BAU tasks to create a better understanding of workload impact. |
|||
|
4 #1113 |
Potential Non-compliance with Health and Safety at Work Act 2015 |
20 |
8 |
S ↔ |
|
Status update |
Risk rating unchanged for the time being. Improvements with the H&S process risk will lower this non-compliance H&S risk. Ongoing training and Work as Done Audits reduce the risk over time. |
|||
|
5 #1017 |
Cyber security attack |
20 |
8 |
S ↔ |
|
Status update |
Ongoing improvements and controls implemented to manage the ongoing and increasing risk of cyber-attacks. Current global uncertainty with the war in Iran is generating a heightened level of cyber warfare activity. Increased level of visible attacks has been observed in the last quarter. |
|||
|
6 #1109 |
Management of data and information assets |
16 |
8 |
S ↔ |
|
Status Update |
Risk remains as we begin a project to discover, document and create an information asset register. This includes the classification of data in Sharepoint in respect of sensitivity through an AI auto generation tool. Once data is classified controls can be applied to manage the data appropriately. |
|||
|
7 #1069 |
Local Government Structural Reform – Impact on regional governance and outcomes |
16 |
6 |
D â |
|
Status Update |
A council led programme is currently in the early stages of implementation and includes participation from District Councils within the Northland Region. |
|||
|
8 #1039 |
Ongoing Impacts from Significant Change Management |
16 |
12 |
S ↔ |
|
Status Update |
Risk rating unchanged. Change fatigue remains a concern. Greater visibility of change projects is developing to inform a change programme. |
|||
|
9 #1006 |
Biosecurity Incursions |
15 |
6 |
D â |
|
Status Update |
No new to northland pests have been brought to our attention however a watch is still being kept on yellow legged hornet in Auckland |
|||
|
10 #1001 |
Dealing with aggressive people – psychological harm (staff capability) |
15 |
12 |
I á |
|
Status Update |
Increase in consequence. While isolated, aggressive behaviour is more widely reported via H&S reporting. Additional controls (process/technology) are under investigation. |
|||
|
11 #1026 |
Investment Portfolio Financial Risk |
15 |
9 |
S ↔ |
|
Status Update |
New fund managers are providing improved reporting and fund monitoring and the new SIPO and fund manager approach has provided for greater diversification and therefore risk spread. |
|||
|
12 #1189 |
Staff Adoption and sustained engagement, usability and cultural integration software management programme (WayPoint) |
15 |
6 |
D â |
|
Status Update |
Actions are ongoing with multiple system and reporting improvements already underway. Regular reporting allows visibility of training requirements and ongoing support therefore a reduction in residual rating has been applied. |
|||
|
13 #1096 |
Policies and Protocols not clearly documented or followed
|
16 |
8 |
S ↔ |
|
Status Update |
The Policy register is subject to ongoing review and updates to ensure alignment with the current environment and technological requirements. As a result, the risk rating remains unchanged. |
|||
|
14 #1295 |
Resource Management Reform
|
16 |
6 |
N |
|
Risk Description |
Failure to effectively transition to the new resource management system caused by compressed legislative timeframes, limited specialist capacity across the four Northland councils, evolving national direction, and reliance on cross-council coordination, resulting in failure to meet statutory deadlines, fragmented regional planning outcomes and inability to provide for Māori participation as required under the reform legislation. |
|||
Table 3. Operational risks listed - rating high and above
|
Key –Risk rating |
Extreme |
High |
Moderate |
Low |
|
Key – Trend |
Increasing (I) |
Decreasing (D) |
New (N) |
Static (S) |
|
# |
|
Risk Statement |
Inherent Rating |
Residual Rating |
Trend |
|
1 #1007 |
Caulerpa – Threat to marine life, shellfish and marine diversity along Northlands coastline |
20 |
6 |
D â |
|
|
Status Update |
Caulerpa growth has diminished and is not expected to accelerate over winter the work on the underwater harvester is proceeding in accordance with the timeline int eh contract and will be ready by June of this year. |
||||
|
2 #1095 |
PF2050 Funding Cessation Impacting Biosecurity Outcomes, Workforce and Community Support |
20 |
12 |
S ↔ |
|
|
Status update |
Still uncertainty for funding and staff are following up with Foundation North as to opportunities for the continuation of the programme. As outlined in a report prepared for a Council workshop we await funding confirmation.
|
||||
|
3 #1042 |
Tāiki ē Strategic intent Te Tiriti Strategy and Implementation Plan |
20 |
8 |
S↔ |
|
|
Status update |
Taiki e Strategic Intent is being embedded across council and reported via waypoint to ensure transparency and accountability to council |
||||
|
4 #1155 |
Madagascar Ragwort – Risk to rural economy and reputational risk to council |
20 |
20 |
S ↔
|
|
|
Status update |
No change to the current status of this risk with an update expected in May 2026.
Council approved funding of $277,000 for the council’s share of the economic impact assessment and position paper development and to progress priority actions for awareness and advocacy, distribution mapping and identification, and biological control. A multi-channel awareness campaign is currently underway, jointly funded with MPI, running until June, and new event display materials and hard copy resources have been produced. Staff in the Biocontrol & Molecular Ecology team at the Bioeconomy Science Institute are developing and costing a detailed research plan for stage 1 of the biocontrol project and DNA test development, and a tool to help with identification has been commissioned. Further survey has been completed, with more planned, and a public mapping interface is in development.
The intention of this funding allocation was to enable key work to be initiated while the shared cost model was progressed with industry and central Government. Industry partners and MPI have been presented with scaled options for a cost share model for an initial 12-month period, based on a the jointly commissioned position paper, but to date has received limited support. Staff are pursuing a formal response.
|
||||
|
5 #1029 |
Climate change response |
12 |
8 |
S ↔ |
|
|
Status update |
Risk is trending upwards as government direction changes bringing uncertainty to some areas of the climate programme. Work will continue to manage controls with a review of the risk likely once new legislation has been released. |
||||
|
6 #1005 |
Treaty Settlements |
16 |
12 |
S ↔ |
|
|
Status update |
Communications happen between relevant parties and council through Te Ruarangi and iwi settlement entities (incl. Te Oneroa a Tohe Board) |
||||
|
7 #1052 |
Gold Clam Biosecurity Response |
20 |
10 |
S ↔ |
|
|
Status Update |
Awaiting confirmation from Kaipara District Council relating to providing wash stations to reduce the risk of Gold Clam |
||||
|
8 #1067 |
Continuation of Kauri Protection Funding |
12 |
12 |
S ↔ |
|
|
Status Update |
Uncertainty for funding remains and staff are seeking clarity from MPI with future funding beyond 2026/27 unclear. |
||||
|
#1037 |
Flood Infrastructure Failure
|
20 |
15 |
S ↔ |
|
|
Status Update |
Asset Management maturity is developing and will support ongoing achievement of this KPI. Key to lifting our maturity levels is the introduction into service of an asset management tool. This is on track to be delivered by 31 Aug 2026. It is anticipated that the tool will be fully functional by end of 2026 which will enable the residual risk to be reassessed. |
||||
Deep Dives
The Corporate Strategy Team facilitates risk owners to provide deep dives into each risk in accordance with the following schedule (Table 4), initially focussing on the risk with the highest pre-controls risk rating or where specifically requested due to increasing risk ratings.
Table 4. Risk deep dive schedule.
|
Risks |
Nov 24 |
Feb 25 |
May 25 |
Aug 25 |
Nov 25 |
Feb 26 |
May 26 |
Aug 26 |
Nov 26 |
|
|
1109
1017 |
Management of data and information assets Cyber Security Update |
√
√ |
|
|
|
|
|
|
|
|
|
|
Use of Firearms |
|
√ |
|
|
|
|
|
|
|
|
1052 |
Gold Clam Biosecurity Response |
|
|
√ |
|
|
|
|
|
|
|
1096 |
Policies and protocols |
|
|
|
√ |
|
|
|
|
|
|
1064 |
Inefficient Contract Management programme |
|
|
|
|
|
√ |
|
|
|
|
1189 |
Project “WayPoint” Staff adoption and sustained engagement, usability and cultural integration |
|
|
|
|
|
|
√ |
|
|
|
1000 |
External and internal pressures impacting work programme delivery (Workload) |
|
|
|
|
|
|
|
√ |
|
|
1039 |
Ongoing impact from significant change management |
|
|
|
|
|
|
|
|
Attachments/Ngā tapirihanga
Attachment 1:
Project management software (WayPoint) staff adoption and sustained engagement,
usability and cultural integration ⇩
Audit and Risk Committee item: 6.5
19 May 2026
|
TITLE: |
Internal Audit Schedule |
|
From: |
Mandy Tepania, Audit and Assurance Lead |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
This report provides an overview of audits planned or being carried out.
· Table 1 provides a brief overview of the audit schedule (external /internal provision).
That the report ‘Internal Audit Schedule’ by Mandy Tepania, Audit and Assurance Lead and dated 8 May 2026, be received.
Background/Tuhinga
|
INTERNAL AUDIT - SCHEDULE |
|
|
|
|
|
|
|
|
Priority |
|
|
Audit item |
Audit summary / agreed scope |
Status |
1-High 3 low) |
Timing |
|
INTERNAL AUDITS external provision |
|
|
|
|
|
Risk Appetite |
Development of Risk Appetite Statements with ELT (including workshop with elected members) |
Underway |
1 |
Jun-26 |
|
Vehicles |
Fit for purpose Fleet and Utilisation |
TBC |
2 |
|
|
Credit card |
Effectiveness and efficiency |
Underway |
1 |
|
|
Forensics |
Forensic audit - Conflict of interest, vendors/staff on companies register, next of kin, bank accounts |
Underway |
1 |
|
|
Grant funding |
Internal grant funding, review policies, processes, and outcome monitoring |
Underway |
1 |
June /Sept 2026 |
|
Grant funding |
Base on principles of OAG guidelines on grant funding - checking clear purpose, audit, funding arrangements and documented decisions, record keeping, managing COI, monitoring and management of decision-making decisions. |
Underway |
1 |
June /Sept 2026 |
|
Project management audit |
PWC to do audit of project management - our framework, processes, where we need to start with a roadmap/gap analysis? |
Underway |
1 |
|
|
Biodiversity S17a PLUS review |
Extended review of service delivery |
Underway |
2 |
Jun-26 |
|
Natural Resources S17a PLUS review |
Extended review of service delivery |
Complete |
|
Mar-26 |
|
IT security settings |
ALGIM Local Government Cybersecurity Framework Assessment based on the CIS Critical Security Controls V7.1 - standard for establishing the level of information system operational security - Risk R00014 Cyber Security Attack |
Ongoing |
ALGIM Program |
|
|
Integrity Analytics - year end |
Integrity Analytics (Accounts Payable, Bank Payments, related parties, Sensitive expenditure and payroll) plus technology fee External audit completed by Deloitte – Annual Report audit |
Underway |
|
Jun-26 |
|
Forest management (Mt Tiger/Taika) |
Forest revaluation currently underway. Previously scoped as an audit of effectiveness of outsourced management, harvest schedule, health and safety compliance, and reporting. Draft re-evaluations report due 30 April 2026. |
Underway |
|
Jun-26 |
|
One off review of procurement and contract management |
Once we have the new system up and running, it is important to have checks and balances in place |
On hold new system |
|
|
|
Change Management |

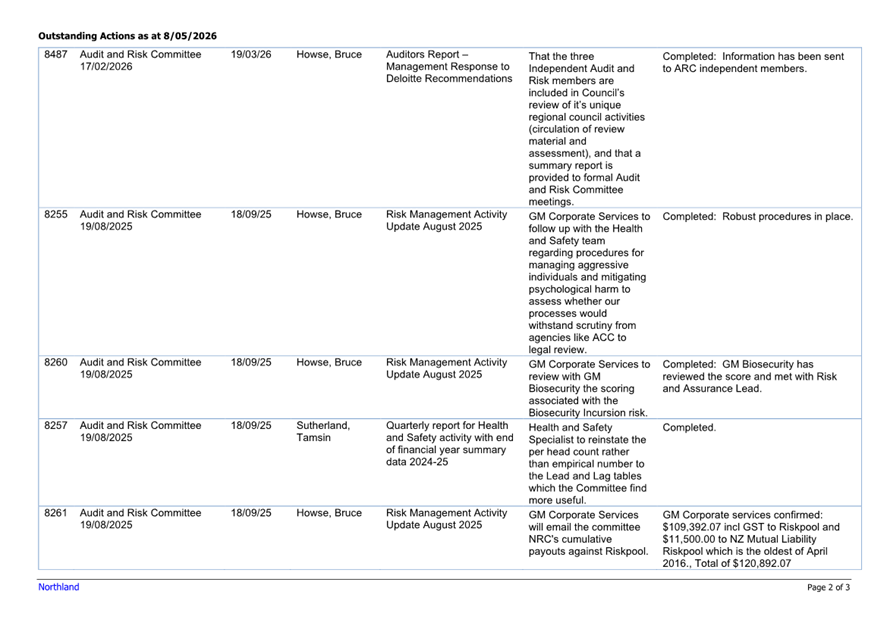

Initial deep dive for audit and risk (Shane and Steph); Suggest that off the back of this an extensive review may be required. |
Pending |
|
|
|
Fraud gap assessment |
External audit provided by Deloitte - every four yrs |
Pending every four years |
|
2028 |
|
INTERNAL AUDITS internal provision |
|
|
|
|
|
Business continuity - audit |
Audit to review systems and processes in place against national best practice and lessons learned, conduct gap analysis. |
Underway |
1 |
Jun-26 |
|
Business continuity - ongoing |
Annual Business Continuity Review – meeting with critical functioning services within NRC to ensure plans are up to date (contacts etc) |
Pending |
1 |
Dec-26 |
|
Pathway (quality) audits |
New Quality program is underway across 24 different service delivery groups within NRC. |
Pending |
2 |
Ongoing |
|
Staff benefit policies audit |
This review will include all policy relating to staff /councillor benefits/remuneration: Credit card, Travel, Expenditure. |
Underway |
2 |
Jun-26 |
|
Vehicle Usage |
Audit on current use - Internal audit identified difficulties in matching vehicle use with business activities. Recommend Vehicle Fleet Policy review. |
Complete |
2 |
|
|
Catering |
Audit on consistency with Policy and procedures (Budget, approval) An internal audit identified gaps in policy clarity and approval processes, indicating a need to strengthen assurance over how arrangements are governed and applied. (Sensitive Expenditure and Allocation of Council time and resources procedures & Guidelines) |
Complete |
2 |
|
|
Procurement |
Review procurement processes to identify non‑compliance,
inefficiencies, and cost‑saving opportunities in support of the
Contract Management Audit already completed. |
Paused |
1 |
Ongoing |
|
Annual review of procurement and contract management |
Once we have the new system up and running, it is important to have checks and balances in place |
Pending |
1 |
2027 2028 |
|
Governance |
A review of all administrative and LGOIMA governance requirements, including standards, Standing orders, Terms of reference for committees etc. Ensuring consistency, transparency and assurance. |
Pending |
2 |
|
|
Onboarding new and returning to work staff |
Staff returning to work, maternity work, new staff, processes, providing updates, follow up, record keeping, legislative compliance etc. Different process depending which departments? |
Pending |
2 |
Quality outcome |
|
Floor plan redesign / hotdesking - learnings and opportunities |
Suggest that it might be worthwhile doing an audit on the process (ground floor) and look for universal learnings (that can be applied to other parts of the business) |
Pending |
2 |
Quality outcome |
Attachments/Ngā tapirihanga
Nil
Audit and Risk Committee item: 6.6
19 May 2026
|
TITLE: |
Fraud, Corruption and Dishonesty Activity Report |
|
From: |
Mandy Tepania, Audit and Assurance Lead |
|
Authorised by Group Manager/s: |
Bruce Howse, Pou Taumatua – Group Manager Corporate Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
That the report ‘Fraud, Corruption and Dishonesty Activity Report’ by Mandy Tepania, Audit and Assurance Lead and dated 8 May 2026, be received.
Background/Tuhinga
As a public sector organisation, the council is entrusted with ratepayer funds and its staff, consultants, volunteers, contractors, and elected members are expected to maintain public trust by exhibiting the highest standards of integrity and honesty throughout all council’s activities.
Definition:
Fraud: - Is an intentional and dishonest act involving deception or misrepresentation, to obtain or potentially obtain, an advantage for themselves or any other person/organisation.
Dishonesty: - An act (or omission) undertaken without the belief that there is consent or authority for doing the act (or omission).
Corruption: - Refers to a person in authority exploiting their position for personal gain (e.g., receive gifts or other benefits to perform part of an official function, or omitting to perform an official duty resulting in personal gain for another).
A policy provides an outline to staff when reporting dishonest behaviour to the Fraud Limitations Officer (FLO). The procedure below outlines the steps taken.

This report provides several summaries:
· Chart below provides a quick view of the 10 Fraud, Corruption and Dishonesty Risks Inherent/Residual controls in Table 1.
· Fraud Corruption and Dishonesty Risk Register including status updates completed this quarter in Table 2.
· Risk Management Matrix Evaluation Tool (ranking) Inherent/Residual Table 3.
Table 1. Report showing all Fraud Corruption and Dishonesty Risks scores (Inherent/Residual)
Table 2. Fraud Corruption and Dishonesty Risk Register current rating and controls.
Risks below are identified in the risk register as ongoing risks with controls in place to manage and monitor any breach in behaviours. All risks on this register have been reported including a status update for each. Risk ratings are adjusted when a regular review identifies and requires a policy or process change be made to remove or limit chances of fraudulent, corrupt or dishonest behaviours.
|
Inherent Rating |
Extreme |
High |
Moderate |
Low |
|
Residual Rating |
Extreme |
High |
Moderate |
Low |
|
|
Risk Statement |
Inherent Rating |
Residual Rating |
|
|
1 #1033 |
Data Loss through theft, unauthorized access, or distribution |
9 |
6 |
|
|
Status Update |
No change to risk rating at present. New and increasing security controls are being implemented however this is balanced by the increasing use of AI and initiatives for shared access to systems being requested. |
|||
|
2 #1112 |
Theft and inappropriate use of council assets
|
6 |
4 |
|
|
Status Update |
Established processes and policies provide a clear framework for identifying inappropriate use, with day-to-day monitoring undertaken by staff. |
|||
|
3 #1110 |
Conflict of Interest
|
9 |
6 |
|
|
Status Update |
No change to current risk rating. Conflict of interest training rolled out. Exploring opportunities for external audit alongside the internal monitoring. Expecting that the likelihood will reduce in future. |
|||
|
4 #1051 |
Supplier Invoice Fraud |
6 |
2
|
|
|
Status Update |
Implementation of automated invoice receipting has improved validation of invoices. |
|||
|
5 #1020 |
Bribery and inappropriate receipt of gifts & secondary employment |
6 |
6 |
|
|
Status Update |
Monitoring ongoing. Conflict of interest training rolled out to the organisation to raise awareness. |
|||
|
6 #1044 |
Fraud Corruption and Dishonesty
|
10 |
5 |
|
|
Status Update |
No incidents identified this quarter. Ongoing mitigations to ensure process and controls remain robust. |
|||
|
7 # 1111 |
Recruitment Fraud
|
6 |
4 |
|
|
Status Update |
No change to risk. Active monitoring is ongoing. |
|||
|
8 #1053 |
Timesheet and expense claim fraud
|
6 |
4 |
|
|
Controls |
Monthly budget monitoring and reporting; Manager approval; Operational procedure compliance; authorisation process and workflow, police checks obtained where necessary; timesheets, sickness, other leave signed off by manager; internal audit where appropriate. |
|||
|
9 #1057 |
Material misstatement of the financial statements
|
6 |
3 |
|
|
Status Update |
Processes remain the same for both monthly and annual reporting with oversight in conjunction with finance manager. |
|||
|
10 #1103 |
Payroll Fraud
|
3 |
2 |
|
|
Status Update |
Current procedures meet controls |
|||
Table 3. Risk Management Matrix Evaluation Tool (to explain the ranking) Inherent/ Residual
|
Likelihood |
Consequence |
||||||
|
Inconsequential (1) |
Minor (2) |
Moderate (3) |
Major (4) |
Severe (5) |
|||
|
Frequent (5) |
5 Moderate |
10 High |
15 Extreme |
20 Extreme |
25 Extreme |
||
|
Often (4) |
4 Low |
8 High |
12 High |
16 Extreme |
20 Extreme |
||
|
Likely (3) |
3 Low |
6 Moderate |
9 High |
12 High |
15 Extreme |
||
|
Possible (2) |
2 Low |
4 Low |
6 Moderate |
8 High |
10 High |
||
|
Rare (1) |
1 Low |
2 Low |
3 Low |
4 Low |
5 Moderate |
||

Fraud Limitations Officer updates:
No fraudulent behaviours have been reported in this quarter.
Attachments/Ngā tapirihanga
Nil
Audit and Risk Committee item: 6.7
19 May 2026
|
TITLE: |
Regulatory Services Quarterly Report |
|
From: |
Colin Dall, Pou Whakaritenga - Group Manager Regulatory Services |
|
Authorised by Group Manager/s: |
Colin Dall, Pou Whakaritenga - Group Manager Regulatory Services, on 08 May 2026 |
Whakarāpopototanga / Executive summary
Whakarāpopototanga / Executive summary
This report covers the council’s consent processing and compliance monitoring functions/activities for the third quarter of the 2025/2026 financial year (1 January to 31 March 2026). A separate report on formal enforcement activities is included in the Confidential section of this committee agenda.
The following is a high-level summary of our consent application processing and compliance monitoring functions/activities during the reporting period:
Consents
Table 1: 1 January to 31 March 2026
|
Metric |
January 2026 |
February 2026 |
March |
Period Total |
2025/2026 Total |
|
Applications received1 |
13 |
26 |
21 |
60 |
286 |
|
Decisions issued2 |
23 |
28 |
27 |
78 |
302 |
|
Outside timeframes |
0 |
0 |
0 |
0 |
0 |
|
Hearings |
0 |
0 |
0 |
0 |
0 |
|
Objections/Appeals |
0 |
0 |
0 |
0 |
0 |
1 An application may include multiple activities which individually require a resource consent.
2 The number of decisions issued include applications for both single and bundled activities which required a resource consent.
Of the applications in progress at the end of March 2026, 25 were received more than 12 months ago (two less than the previous reporting period).
Details of the consent applications received, the consent decisions issued and consent applications received more than 12 months are given in Tables 3 to 5 in Background/Tuhinga section of this report.
Compliance Monitoring Events
Table 2: 1 January to 31 March 2026
|
Classification |
Total |
Full Compliance |
Low Risk Non-compliance |
Moderate Non-compliance |
Significant Non- compliance |
|
Air Discharge |
42 |
40 |
1 |
1 |
0 |
|
Bore Consent |
8 |
4 |
4 |
0 |
0 |
|
Coastal Discharge |
32 |
24 |
1 |
7 |
0 |
|
Coastal Permit |
153 |
111 |
2 |
40 |
0 |
|
Land Discharge |
101 |
70 |
15 |
15 |
1 |
|
Land Use Consent |
110 |
92 |
7 |
8 |
3 |
|
Water Discharge |
115 |
65 |
15 |
34 |
1 |
|
FDE – Discharge permit |
63 |
63 |
0 |
0 |
0 |
|
FDE – Permitted activity |
0 |
0 |
0 |
0 |
0 |
|
NES-F |
16 |
6 |
1 |
9 |
0 |
|
Water Permit |
16 |
15 |
1 |
0 |
0 |
|
Water Take |
295 |
209 |
64 |
22 |
0 |
|
Period Total |
951 |
699 |
111 |
136 |
5 |
|
Percentage |
|
73.5% |
11.7% |
14.3% |
0.5% |
|
2025/2026 Total |
4022 |
3027 |
429 |
492 |
74 |
|
Percentage |
|
75.3% |
10.7% |
12.2% |
1.8% |
Environmental Incidents
A total of 415 environmental incidents were recorded and investigated in the reporting period:
|
January 2026 |
February 2026 |
March 2026 |
Total |
|
178 |
129 |
108 |
415 |

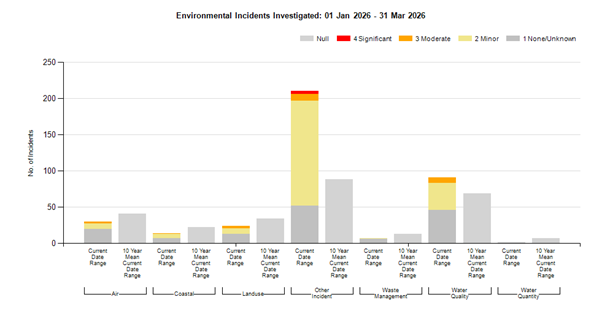

The following graph compares the number of environment incidents investigated for each main incident category with the mean (average) number of incidents investigated for the same category and reporting period for the previous 10-year period. The colour coding for the incidents investigated in the current reporting period gives the assessed scale of adverse effects of the incident.

That the report ‘Regulatory Services Quarterly Report’ by Colin Dall, Pou Whakaritenga - Group Manager Regulatory Services and dated 1 May 2026, be received.
Background/Tuhinga
Compliance ratings specified in this report are those recommended by the Ministry for the Environment’s “Best Practice Guidelines for Compliance, Monitoring and Enforcement under the Resource Management Act 1991” (2018):
|
Compliance Grade |
|
FULL COMPLIANCE with all relevant consent conditions, plan rules, regulations, and national environmental standards. |
|
LOW RISK NON-COMPLIANCE – Compliance with most of the relevant consent conditions, plan rules, regulations, and national environmental standards. Non-compliance carries a low risk of adverse environmental effects or is technical in nature (e.g. failure to submit a monitoring report). |
|
MODERATE NON-COMPLIANCE – Non-compliance with some of the relevant consent conditions, plan rules, regulations, and national environmental standards, where there are some environmental consequences and/or there is a moderate risk of adverse environmental effects. |
|
SIGNIFICANT NON-COMPLIANCE – Non-compliance with many of the relevant consent conditions, plan rules, regulations, and national environmental standards, where there are significant environmental consequences and/or a high risk of adverse environmental effects. |
Table 3: Applications Received 1 January to 31 March 2026
|
IRIS ID |
Consents Required |
Received Date |
Applicant |
Description |
|
APP.001200.01 |
3 |
13/01/2026 |
Lifestyle Holiday Parks Limited |
Discharge associated with a wastewater system and water take for a campground at Puketona Road, Haruru. |
|
APP.047241.01 |
3 |
14/01/2026 |
D Bellamy Family Trust & D N Bellamy |
Earthworks for a new farm dairy effluent pond, Island Road, Turiwiri. |
|
APP.042407.01 |
1 |
19/01/2026 |
AINZ Fund 12 Limited |
Section 125 extension of lapse period to take water from an unnamed tributary of the Mangawhai Harbour, at Molesworth Road, Mangawhai. |
|
APP.010520.07 |
2 |
20/01/2026 |
Tawhiti Whenua Limited |
Replacement of an expired consent to deposit crushed rock and sand material onto the foreshore at Crowles Bay, Te Puna Inlet, Bay of Islands. |
|
APP.047250.01 |
3 |
20/01/2026 |
Taraire Tahi Limited |
Earthworks for accessways and building platforms at Riddell Road, Kerikeri. |
|
APP.010692.06 |
4 |
27/01/2026 |
Whangarei District Council – Parks |
Change to consents related to beach contouring and a reclamation. |
|
APP.035857.01 |
1 |
27/01/2026 |
Salt Air Limited |
Resource consent for swing mooring 3622 at Otehei Bay, Urupukapuka, Bay of Islands. |
|
APP.047253.01 |
3 |
27/01/2026 |
L Davies |
Bore construction at Edginton Road, Glenbervie. |
|
APP.042442.01 |
1 |
28/01/2026 |
Te Tai Tokerau Water Trust |
Section 125 to extend the lapse period for AUT.042442.01.02 and AUT.042442.02.02 – To take water from the Okapakapa Stream and Aratapu Streams for a water storage scheme on the Poutō Peninsula. |
|
APP.047258.01 |
3 |
28/01/2026 |
Marsden City Limited Partnership |
Bore construction for subdivision works at Theodore Drive, Ruakākā. |
|
APP.047259.01 |
3 |
28/01/2026 |
G S Dairy Co Limited |
Earthworks to enlarge an effluent pond at Access Road, Rūāwai. |
|
APP.047260.01 |
1 |
29/01/2026 |
Henry John Murphy Whanau Trust |
Discharge wastewater to land at Russell Road, Ōākura. |
|
APP.047261.01 |
3 |
30/01/2026 |
Whangarei District Council – Roading |
Slip remediation works at the corner of Whangarei Heads Road and Whangarei Heads School Road, Whangarei Heads. |
|
APP.002344.01 |
1 |
3/02/2026 |
Mangawhai Golf Club Incorporated |
Section 127 change to a groundwater take for golf course irrigation and club house purposes at Molesworth Drive, Mangawhai. |
|
APP.047263.01 |
3 |
3/02/2026 |
Whangarei District Council – Roading |
Earthworks to establish a clean fill area at Russell Road, Punaruku, to dispose of landslide material from public roads. |
|
APP.047266.01 |
1 |
4/02/2026 |
Te Runanga o Ngai Takoto |
Earthworks for an egg farm development at Sandhills Road, Ahipara. |
|
APP.047269.01 |
4 |
4/02/2026 |
Northland Regional Council |
Kaihu Flood Management Scheme – Machine cleaning works (removing obstructions such as vegetation, sediment buildup, and debris from the riverbed and banks) south of the Parore West Road bridge. |
|
APP.047270.01 |
5 |
5/02/2026 |
Kaipara District Council |
Repair existing hard protection structures that protect roading infrastructure at Mangawhai Harbour. |
|
APP.047272.01 |
3 |
5/02/2026 |
W Morris-Whyte |
Earthworks in a flood zone within 10 metres of a wetland at Jack Boyd Drive, Mangawhai. |
|
APP.047273.01 |
3 |
5/02/2026 |
Jay Courtenay |
Bore construction at Mataroa Way, Pukenui. |
|
APP.047274.01 |
3 |
5/02/2026 |
Whangarei District Council – Roading |
Cleanfill site for landslide material at Russell Road, Helena Bay. |
|
APP.047275.01 |
3 |
5/02/2026 |
Tale Foufoupule Neki |
Install and maintain a bore at West Coast Road, Waipapakauri. |
|
APP.047276.01 |
3 |
9/02/2026 |
Far North District Council |
Replace an existing road culvert at Taemaro Bay Road, Hihi. |
|
APP.046061.01 |
3 |
10/02/2026 |
Mangawhai Hills Limited |
Section 127 change to earthworks for subdivision development at Cove Road, Mangawhai. |
|
APP.047285.01 |
1 |
13/02/2026 |
D J Nilsson |
Earthworks for dam construction at Baylys Coast Road, Dargaville. |
|
APP.047286.01 |
1 |
13/02/2026 |
Paahekoheko General Partner Limited |
Earthworks for a proposed poultry farm at Sterling Road, Paparoa. |
|
APP.047287.01 |
1 |
13/02/2026 |
O'Rourke Business Trust & D R O'Rourke & A N O'Rourke |
Earthworks at Jacentho Road, Peria Valley. |
|
APP.046509.01 |
1 |
17/02/2026 |
McCallum Bros Limited |
FTAA application – Sand Mining, Bream Bay. |
|
APP.047289.01 |
3 |
17/02/2026 |
New Zealand Transport Agency – Waka Kotahi |
Urgent slip repair works adjacent to State Highway 1 Akerama Curves, Hukerenui. |
|
APP.047291.01 |
1 |
18/02/2026 |
East Property Investments Limited |
Subdivision earthworks and associated activities in a flood zone at Yorke Road, Haruru. |
|
APP.047292.01 |
2 |
19/02/2026 |
The Palms Lifestyle Village Limited |
Agrichemical discharge to eradicate Lagarosiphon major (Lagarosiphon/oxygen weed) to water within a manmade stormwater pond at Reed Street, Whangārei. |
|
APP.009080.01 |
1 |
20/02/2026 |
Northland Regional Landfill Limited Partnership |
Amendments to conditions relating to the authorised footprint of Stage 5A and the operational classification of a portion of Stage 5A. |
|
APP.047295.01 |
1 |
23/02/2026 |
S & H McLeod |
Earthworks in a flood hazard area to raise ground levels for future building platforms at Cove Road, Waipū. |
|
APP.047296.01 |
3 |
24/02/2026 |
Northland Regional Landfill Limited Partnership |
Retrospective consent for three monitoring bores at Purewa Landfill, State Highway 1, Marusumi Road, Maungakaramea. |
|
APP.015967.03 |
4 |
25/02/2026 |
Cavalli Properties Limited |
Replacement consents for a wastewater pipeline and earthworks associated with a residential subdivision at Matauri Bay. |
|
APP.047300.01 |
3 |
26/02/2026 |
B B & S R Williams |
Bore construction for domestic and stock use at Tahanga Road, Karikari Peninsula. |
|
APP.002667.01 |
4 |
27/02/2026 |
Far North District Council |
To discharge treated wastewater into the coastal marine area of the Hokianga Harbour, at or about location co‐ordinates 1634768E 6069462N at Opononi/Ōmāpere Wastewater Treatment Plant. |
|
APP.028589.01 |
1 |
27/02/2026 |
Far North District Council |
Stock truck effluent disposal site, Pakaraka. |
|
APP.047309.01 |
1 |
27/02/2026 |
Far North Housing Limited |
Earthworks within a flood hazard area for site development works at Puckey Ave, Kaitāia. |
|
APP.047310.01 |
1 |
4/03/2026 |
Rehoboth 2 Limited |
Water diversion and earthworks near a wetland at Gee Road, Matakohe. |
|
APP.047313.01 |
2 |
4/03/2026 |
Whakatere Investments Limited |
Discharge wastewater for a proposed papakāinga at Mangakāhia Road, Kaikohe. |
|
APP.047314.01 |
1 |
4/03/2026 |
Winnie Mitchell Descendants Whanau Trust |
Earthworks and wastewater discharge for a papakāinga at Matawaia-Maromākū Road, Matawaia. |
|
APP.047315.01 |
3 |
5/03/2026 |
Waitomo Papakainga Development Society Incorporated |
Earthworks for site development at Grigg Street, Kaitāia. |
|
APP.047316.01 |
1 |
6/03/2026 |
Strataform Limited |
Discharge treated wastewater to land from a restaurant and tasting room at State Highway 10, Mangonui. |
|
APP.047324.01 |
1 |
12/03/2026 |
Portside Link Limited |
Bulk earthworks for a commercial development at Marsden Point Road, Ruakākā. |
|
APP.047325.01 |
1 |
12/03/2026 |
Arapaoa 1 Maori Reservation Trust |
Discharge wastewater for a papakāinga at Arapaoa Road, Tinopai. |
|
APP.047326.01 |
1 |
12/03/2026 |
Northland Regional Council |
Temporary dewatering during works at Turner Street, Kāeo. |
|
APP.021532.07 |
1 |
13/03/2026 |
Whangarei District Council – Waste & Drainage |
Section 125 extension to lapse period for a Ruakākā wastewater treatment plant discharge to the coastal marine area and structures in the coastal marine area at Ruakākā. |
|
APP.004702.01 |
1 |
18/03/2026 |
Kaipara District Council |
Replacement consents for a water take and wastewater discharges at Pine Beach Camp, Taharoa Domain, Kai Iwi Lakes. |
|
APP.047332.01 |
1 |
19/03/2026 |
LM Consulting Limited |
Earthworks and associated activities to install erosion protection on the eastern bank of Waiarohia Stream at Whangarei Intermediate School, Rust Avenue, Whangārei. |
|
APP.047333.01 |
1 |
19/03/2026 |
Whatitiri Maori Reserves Trust |
Discharge wastewater to land from Maungarongo Marae, Mangakāhia Road, Porotī. |
|
APP.019884.01 |
1 |
20/03/2026 |
KiwiRail Holdings Limited |
Section 127 change to reclamation and associated activities for rail corridor Oakleigh to Marsden Point (ENV-2010-AKL-000004). |
|
APP.042100.01 |
1 |
20/03/2026 |
Paihia Maritime Properties |
Occupy space in the coastal marine area with, and use, the following existing and proposed structures: - Restaurant and aquarium building and an associated deck; - Kitchen and bar facility; - Piled deck for public viewing and outdoor dining purposes; - Canopy structures over the deck and bar; - Berth piles and gantry for temporary mooring of vessels for gamefish weighing purposes; - Utility services including telecommunications, water and sewer lines associated with the structures and aquarium; - Pontoon facility (inclusive of floating pontoons and an access gangway); - Rock abutment (Eastern Abutment) for the purpose of beach protection. |
|
APP.047335.01 |
1 |
23/03/2026 |
S E & P M Herbert |
Earthworks within a flood hazard zone at Paroa Road, Russell. |
|
APP.047337.01 |
1 |
24/03/2026 |
Waipuna Marae Trust |
New onsite wastewater system for marae buildings at West Coast Road, Panguru. |
|
APP.047340.01 |
1 |
24/03/2026 |
Whangarei District Council – Waste & Drainage |
Earthworks and associated activities to support the Port Road Stage 2 Rising Main Works at railway corridor, Port Road and Kioreroa Road, Whangārei. |
|
APP.047383.01 |
1 |
25/03/2026 |
United Civil Construction Limited |
Temporary groundwater take for a solar farm project at Ruakākā Energy Park. |
|
APP.047384.01 |
1 |
26/03/2026 |
Kaikohe Berryfruit Limited Partnership |
Water take for horticulture use at State Highway 12, Kaikohe. |
|
APP.047385.01 |
1 |
27/03/2026 |
Meridian Energy Limited |
Culverts within Site 1 (Bercich Drain) of the Ruakākā Solar Farm at Rama Road/State Highway 15, Ruakākā. |
|
APP.047388.01 |
1 |
31/03/2026 |
Mrs S V Rawnsley |
Bore construction at Kimberley Road, Ngataki. |
Table 4: Consents Decisions Issued 1 January to 31 March 2026
|
IRIS ID |
Consents Required |
Issue Date |
Applicant & Description |
|
|
AUT.007145.01.05 |
4 |
12/01/2026 |
Whangarei District Council – Discharge leachate to land at closed landfill at Pohe Island |
|
|
AUT.015995.01.02 |
1 |
12/01/2026 |
Atlas Quarries Limited – Air discharge from concrete batching plant at Allis Bloy Place, Ruakākā. |
|
|
AUT.047159.01.01 |
3 |
13/01/2026 |
AINZ Fund 12 Limited – Earthworks for subdivision works for Stages 5 and 6 at Molesworth Dr, Mangawhai. |
|
|
AUT.047193.01.01 |
3 |
13/01/2026 |
Kasputys & van Mater – Bore construction at Manawaora Road, Parekura Bay. |
|
|
AUT.047176.01.01 |
5 |
14/01/2026 |
Kaipara District Council – Slip remediation earthworks at Poutō Road, Kelly's Bay. |
|
|
AUT.047194.01.01 |
3 |
14/01/2026 |
Li – Bore construction at Rockell Road, Whananaki. |
|
|
AUT.047169.01.01 |
3 |
19/01/2026 |
Pro Land Matters Company Ltd – Earthworks for site development at Black Swamp Road, Mangawhai. |
|
|
AUT.044860.01.02 |
2 |
20/01/2026 |
Kaipara District Council – Discharge to land for public toilets at Pahi Domain. |
|
|
AUT.047179.01.01 |
6 |
20/01/2026 |
Director General of Conservation – Use a boardwalk in a wetland in the Waipoua Forest. |
|
|
AUT.047192.01.01 |
1 |
20/01/2026 |
Whangarei District Council – Water take from two bores at Stonehaven Drive, Maungakaramea. |
|
|
AUT.047199.01.01 |
2 |
20/01/2026 |
Tappenden Holdings Limited – Discharge to land from upgraded wastewater system at Kempthorne Road, Russell. |
|
|
AUT.047216.01.01 |
3 |
21/01/2026 |
Tutukaka Marina Management Trust – Test bore construction, Tutukaka. |
|
|
AUT.047217.01.01 |
3 |
22/01/2026 |
MP Trustees 2012 Limited & Bell – Bore construction at Port Marsden Highway, Ruakākā. |
|
|
AUT.045568.01.02 |
7 |
23/01/2026 |
Kaipara District Council – Tidal gate in the coastal marine area in the Awaroa River, Rūāwai. |
|
|
AUT.047214.01.01 |
3 |
23/01/2026 |
C & M Rendle Family Trust – Bore construction for domestic use at Te Maire Beach Road, Dargaville. |
|
|
AUT.041823.01.02 |
1 |
27/01/2026 |
Renacer Limited Partnership – Groundwater take from three bores for orchard irrigation at State Highway 1, Pakaraka. |
|
|
AUT.047172.01.01 |
2 |
27/01/2026 |
New Zealand Transport Agency – Slip remediation works in a stream at State Highway 1, Mangamuka. |
|
|
AUT.047219.01.01 |
2 |
28/01/2026 |
Robust – Harvesting of pine trees on Red Zone Land at State Highway 1, Waiōmio. |
|
|
AUT.011080.01.04 |
2 |
29/01/2026 |
Wiroa Properties Limited – Discharge wastewater for tavern and units at Waipapa. |
|
|
AUT.047201.01.01 |
1 |
29/01/2026 |
Ethical Power NZ – Groundwater take for construction use at Marsden Point Road, Ruakākā. |
|
|
AUT.047106.01.01 |
4 |
30/01/2026 |
Mahurangi Oyster Farmers & Dunn – Occupy the coastal marine area with a marine farm in the Kirikiri Inlet, Kaipara Harbour. |
|
|
AUT.047200.01.01 |
3 |
30/01/2026 |
Foote – Earthworks for site level raising at State Highway 10, Waitaruke. |
|
|
AUT.047237.01.01 |
4 |
30/01/2026 |
Te Uri o Hau Settlement Trust – Use the coastal marine area with a marine farm in Kirikiri Inlet, Kaipara Harbour. |
|
|
AUT.004396.01.04 |
1 |
2/02/2026 |
Sherwood Park Golf Club Inc – Groundwater take for a golf club at Millington Road, Maunu, Whangārei. |
|
|
AUT.047083.01.01 |
1 |
2/02/2026 |
Moana New Zealand Limited – Anchorage area in the coastal marine area adjacent to a marine farm in the Whangaroa Harbour. |
|
|
AUT.007209.01.05 |
1 |
3/02/2026 |
Waipu Golf Club Inc – Take groundwater for irrigation of a golf course at State Highway 1, Ruakākā. |
|
|
AUT.047218.01.01 |
3 |
3/02/2026 |
Kerikeri Irrigation Company Limited – Vegetation clearance at Waimate North Road, Kerikeri. |
|
|
AUT.047241.01.01 |
3 |
3/02/2026 |
D Bellamy Family Trust – Earthworks for a new effluent pond at Island Road, Turiwiri, Dargaville. |
|
|
AUT.047232.01.01 |
2 |
4/02/2026 |
Ngatiwai Ki Whangaruru Whenua Topu Trust – Discharge papakāinga wastewater at Rāwhiti Road, Whangaruru. |
|
|
AUT.047157.01.01 |
4 |
5/02/2026 |
Paxton – Site development earthworks in a flood hazard area near a wetland at Komiti Road, Tinopai. |
|
|
AUT.047229.01.01 |
3 |
5/02/2026 |
Kāinga Ora – Homes & Communities – Earthworks in a flood hazard area at Allen Bell Drive, Kaitāia. |
|
|
AUT.029769.01.02 |
1 |
10/02/2026 |
C & S Jaunay Limited – Take surface water for irrigation at Jackson Road, Maungatāpere. |
|
|
AUT.007213.01.03 |
3 |
11/02/2026 |
Onyx Capital Limited – Dam an unnamed tributary of the Otakaranga Stream at Pukeatua Road, Maungatāpere |
|
|
AUT.002361.01.05 |
1 |
13/02/2026 |
Savey Investments Limited – Take and use water from two bores at Bint Road, Maungakaramea. |
|
|
AUT.002773.01.03 |
7 |
13/02/2026 |
Imerys Ceramics New Zealand Limited – Discharge wastewater to the Waipapa Stream. |
|
|
AUT.003383.01.04 |
1 |
13/02/2026 |
Hakaru Farm Trust – Take water for irrigation at Stewart Road, Hakaru. |
|
|
AUT.002135.01.05 |
1 |
16/02/2026 |
McNaughton – Groundwater take for irrigation of horticultural crops at Ngunguru Road, Glenbervie. |
|
|
AUT.002417.01.04 |
4 |
16/02/2026 |
Far North District Council – Kaikohe Wastewater Treatment Plant. |
|
|
AUT.012071.01.02 |
1 |
17/02/2026 |
Waikopu Avocados Limited – Groundwater take for irrigation at Kimberley Road, Ngataki. |
|
|
AUT.047253.01.01 |
3 |
17/02/2026 |
Davies – Bore construction at Edginton Road, Glenbervie. |
|
|
AUT.019507.01.03 |
1 |
18/02/2026 |
Stoneleigh Orchard Limited – Groundwater take for irrigation at Ngunguru Road, Glenbervie. |
|
|
AUT.047236.01.01 |
2 |
18/02/2026 |
Atawhai Trust – Harvesting on Red Zone land at Wright Road, Titoki. |
|
|
AUT.047175.01.01 |
8 |
19/02/2026 |
Waimarie O Whatitiri Marae Trust – Earthworks for disposal site development at Draffin Road, Porotī. |
|
|
AUT.047250.01.01 |
3 |
19/02/2026 |
Taraire Tahi Limited – Earthworks for accessways and building platforms at Riddell Road, Kerikeri. |
|
|
AUT.006849.01.05 |
4 |
20/02/2026 |
Huband Contractors Limited – Extract rock and remove overburden from a quarry at Waihue. |
|
|
AUT.036602.01.02 |
1 |
20/02/2026 |
Rehm & Flippova Trust – Take groundwater for irrigation at Tangihua Road, Maungakaramea. |
|
|
AUT.010692.06.03 |
9 |
23/02/2026 |
Whangarei District Council – Coastal marine area reclamation, Pātaua South. |
|
|
AUT.047258.01.01 |
3 |
23/02/2026 |
Marsden City Limited Partnership – Bore construction at Theodore Drive, Ruakākā. |
|
|
AUT.047261.01.01 |
6 |
24/02/2026 |
Whangarei District Council – Slip remediation works at Whangārei Heads School Road, Whangārei Heads. |
|
|
AUT.047259.01.01 |
3 |
26/02/2026 |
G S Dairy Co Limited – Earthworks to enlarge an effluent pond at Access Road, Rūāwai. |
|
|
AUT.047289.01.01 |
3 |
27/02/2026 |
NZTA – Waka Kotahi – Slip repair works adjacent to State Highway 1 Akerama Curves, Hukerenui. |
|
|
AUT.047235.01.01 |
1 |
2/03/2026 |
Tutukaka Marina Management Trust – Groundwater take for the Tutukaka Marina. |
|
|
AUT.047275.01.01 |
3 |
3/03/2026 |
Neki – Bore construction at West Coast Road, Waipapakauri. |
|
|
AUT.002829.01.05 |
1 |
4/03/2026 |
Kiteroa Water Group & Crum – Surface water take at Otaika Valley Road, Maungatāpere. |
|
|
AUT.047202.01.01 |
4 |
4/03/2026 |
Te Whatu Ora – Health NZ – Earthworks for future site redevelopment at West End Avenue, Horahora. |
|
|
AUT.047273.01.01 |
3 |
4/03/2026 |
Courtenay – Bore construction at Mataroa Way, Pukenui. |
|
|
AUT.007589.01.04 |
1 |
5/03/2026 |
Dansian Limited – Take groundwater for a camp at Mangonui. |
|
|
AUT.012728.01.02 |
1 |
5/03/2026 |
Avon Industries Limited – Discharge contaminants to air at Pipiwai Road, Te Kamo. |
|
|
AUT.047263.01.01 |
3 |
5/03/2026 |
Whangarei District Council – Clean fill area in a flood zone at Russell Road, Punaruku. |
|
|
AUT.047274.01.01 |
3 |
5/03/2026 |
Whangarei District Council – Earthworks for a cleanfill site at Russell Road, Helena Bay. |
|
|
AUT.047276.01.01 |
5 |
6/03/2026 |
Far North District Council – Culvert replacement at Taemaro Bay Road, Taemaro. |
|
|
AUT.010520.07.02 |
3 |
9/03/2026 |
Tawhiti Whenua Limited – Deposit sand in the coastal marine area at Crowles Bay, Te Puna Inlet, Bay of Islands. |
|
|
AUT.002344.01.06 |
1 |
11/03/2026 |
Mangawhai Golf Club Inc – Take groundwater from three bores for a golf club at Molesworth Drive, Mangawhai. |
|
|
AUT.047270.01.01 |
9 |
11/03/2026 |
Kaipara District Council – Hard protection structures in the coastal marine area at Insley Street causeway, Mangawhai. |
|
|
AUT.007256.01.04 |
1 |
12/03/2026 |
Koropewa Farm Limited – Discharge farm dairy effluent at Waiare Road, Puketi. |
|
|
AUT.046061.01.04 |
7 |
13/03/2026 |
Mangawhai Hills Limited – Earthworks for a subdivision development at Cove Road, Mangawhai. |
|
|
AUT.002406.01.05 |
1 |
16/03/2026 |
Cottee, Glenview, Kemp, Anson – Surface water take water for irrigation at Maungatāpere. |
|
|
AUT.047292.01.01 |
2 |
18/03/2026 |
The Palms Lifestyle Village Limited – Discharge agrichemicals to water for weed removal at Reed Street, Tikipunga. |
|
|
AUT.002182.01.06 |
1 |
19/03/2026 |
Apotu Park Orchids Limited – Take water from Mangaharuru Stream, Apotu Road, Kauri. |
|
|
AUT.047326.01.01 |
1 |
20/03/2026 |
Northland Regional Council – Dewatering during works at Turner Street, Kāeo. |
|
|
AUT.002667.01.05 |
4 |
24/03/2026 |
Far North District Council – Discharge treated wastewater to the coastal marine area at Opononi/Ōmāpere Wastewater Treatment Plant. |
|
|
AUT.047300.01.01 |
3 |
24/03/2026 |
Williams – Bore construction for domestic and stock use at Tahanga Road, Karikari Peninsula. |
|
|
AUT.009267.01.03 |
1 |
25/03/2026 |
Pendlewood Farms Limited – Discharge farm dairy effluent at Ōkaihau. |
|
|
AUT.047272.01.01 |
3 |
26/03/2026 |
Morris-Whyte – Earthworks in a flood zone near a wetland at Jack Boyd Drive, Mangawhai. |
|
|
AUT.002652.01.03 |
1 |
27/03/2026 |
Senn – Discharge farm dairy effluent at Larmer Road, Kaitāia. |
|
|
AUT.015967.04.04 |
3 |
31/03/2026 |
Cavalli Properties Limited – Earthworks for 188 lot subdivision at Matauri Bay. |
|
|
AUT.047313.01.01 |
2 |
31/03/2026 |
Whakatere Investments Limited – Discharge wastewater to land for a papakāinga at Mangakāhia Road, Kaikohe. |
|
|
AUT.047315.01.01 |
3 |
31/03/2026 |
Waitomo Papakainga Development Society Inc – Site development earthworks at Grigg Street, Kaitāia. |
|
Table 5: Applications more than 12 months old on 30 March 2026
|
IRIS ID |
Applicant |
Description |
Received Date |
Comments |
|
APP.004835 |
Far North District Council |
Kerikeri urban area stormwater discharges |
4/10/2011 |
Applicant has provided an addendum updating the application documents. Awaiting NRC to complete the Kerikeri Flood Modelling before proceeding notification of the application. |
|
|
|
|
|
Application was returned as incomplete under new provisions of the Resource Management Act. |
|
APP.038180 |
Whangarei District Council |
Comprehensive stormwater network consent for Upper Whangarei Harbour catchments |
25/02/2016 |
Section 37 extension requested by the applicant. Addendum updating the application has been received. The applicant is identifying industrial and trade premises within its network prior to the council proceeding with notification of the application. |
|
|
|
|
|
The application was returned as incomplete under new provisions of the Resource Management Act. |
|
APP.005059 |
Golden Bay Cement |
Stormwater discharges to CMA from a cement manufacturing site, Portland |
9/11/2018 |
Section 128 review. Review of conditions now completed. The council will prioritise the issuing of this decision. |
|
APP.000932 |
Far North District Council |
Replacement consents for the Kaitāia wastewater treatment plant at Bonnetts Road, Kaitāia |
24/08/2021 |
The two heard submitters on this application have withdrawn their wish to be heard. The council is awaiting the applicant’s final agreement on the conditions prior to making a delegated decision on the application. |
|
APP.030602 |
Far North District Council |
Replacement consent for sludge storage facility at Kaitāia – jointly processed with WWTP application |
24/08/2021 |
As above for APP.000932. |
|
|
|
|
|
Delegated decision to grant consent was made in February 2026 and no appeals were received on this decision. |
|
APP.043384 |
G S Jacobsen |
Retrospective consent for a retaining wall and mooring, and proposed new boardwalk, Pukenui |
20/01/2022 |
Section 92 hold for further information. The applicant has confirmed that the structures will be removed . Once the council confirms removal of the structures, then the applicant can withdraw this application. |
|
APP.043888 |
Carrington Estate Jade LP |
Earthworks for residential subdivision at Matai Bay Road and Whatuwhiwhi Road |
30/05/2022 |
Joint notification with FNDC – NRC is lead agency. One submission received from Haititaimarangai 339 Trust opposing the application and wishing to be heard. The council has advised the applicant that it will be returning its application as incomplete under new provisions of the Resource Management Act. However, the council cannot do this until May 2026 and is awaiting response from the applicant on this matter. |
|
APP.007205 |
Far North District Council |
Replacement consents for discharges associated with operation of the Kāeo WWTP |
27/07/2022 |
The council has determined that the application can be processed on a non-notified basis, and draft conditions of consent have been agreed to. The applicant is in discussions with tangata whenua regarding the conditions prior to the council issuing a decision on the application. |
|
APP.007399 |
Far North District Council |
To discharge treated wastewater to Hihi Stream, Hihi Beach WWTP |
31/08/2022 |
The application was publicly notified, with the submission period closing on 22 January 2026. No submissions were received. The council is awaiting agreement from the applicant on draft conditions prior to making a decision on the application under delegated authority. |
|
APP.044441 |
Shoresite Properties Limited |
Bulk earthworks for subdivision at Sun Valley Drive, Morningside, Whangarei |
5/10/2022 |
Section 92 hold for additional information on the stormwater system for subdivision. The council will consider returning the application as incomplete under new provisions of the Resource Management Act. |
|
APP.044619 |
Kiripaka Holdings Limited |
Earthworks for an 84 lot development at Kiripaka Road, Whangarei |
24/11/2022 |
Section 37 extension agreed to by the applicant. The applicant has advised that it is awaiting a geotechnical report for subdivision before progressing any further. The council has followed up with the applicant to confirm that they still wish to proceed with the development. |
|
APP.044727 |
Quail Ridge Country Club Limited |
Proposed pedestrian bridge across Kerikeri River |
24/01/2023 |
Section 92 hold for information on flooding effects. Joint application with FNDC. The applicant has requested public notification and FNDC will be lead agency. No confirmation yet on when the application will be notified. The council will consider returning the application as incomplete under new provisions of the Resource Management Act. |
|
|
|
|
|
The applicant has withdrawn the application. |
|
APP.002773 |
Imerys Ceramics New Zealand Limited |
Renewal of consents for quarrying and processing halloycite and kaolin clay, Takou Bay |
19/04/2023 |
Decision to grant all but one application was issued in February 2026. The remaining application relates to the discharge to air from the processing plant that requires a new consent under the new National Environmental Standard for Greenhouse Gas Emissions (NES GHG). This NES GHG requires an emission plan that has been peer reviewed by a suitably qualified person. The applicant is currently fulfilling this requirement prior to the council continuing to process this application. |
|
APP.002577 |
Far North District Council |
Replacement consents for Rāwene wastewater treatment plant |
28/04/2023 |
Section 37 extension to processing timeframes requested by the applicant to allow it to discuss the application with tāngata whenua and interested groups. The council advised that the application would be publicly notified in early 2026. However, a request has been received from Te Mauri o Te Wai not to proceed with the notification so that a land disposal option can be finalised. After discussion with the applicant, the council has agreed to a Section 37 extension to defer notification until at least 31 December 2027. |
|
APP.019502 |
Far North District Council |
Discharges from Kaitāia Resource Recovery Centre |
31/05/2023 |
Section 37 extension to processing timeframes requested by the applicant to allow it to discuss the application with tāngata whenua. The council has asked for an update on these discussions and has received no response. The council will now continue to process these applications. |
|
APP.045333 |
Pattle Delamore Partners Limited |
Discharges associated with a waste transfer station at 22 Church Street, Kaitāia |
29/08/2023 |
Section 37 extension to processing timeframes requested by the applicant to allow it to discuss the application with tāngata whenua. The council has asked for an update on these discussions and has received no response. The council will now continue to process these applications. |
|
APP.045492 |
VMC Trust |
New swing mooring in Cooks Cove, Motuarohia Island, Bay of Islands |
31/10/2023 |
The applicant has withdrawn the application. |
|
APP.008339 |
Far North District Council |
To discharge treated wastewater, including Russell Landfill leachate, to ground via disposal boreholes |
19/12/2023 |
Section 37 extension to processing timeframes requested by the applicant to provide an update on the investigation into the performance of the disposal system. The applicant has advised that investigation is still ongoing. |
|
APP.045648 |
Whangarei District Council |
Discharge to Ahuroa River from Ahuroa WTP at Waipū |
20/12/2023 |
Section 92 request for additional information has been satisfied. The council is awaiting agreement from the applicant on draft conditions prior to issuing a decision on the application. |
|
APP.045827 |
IDF Development Limited |
Jetty and associated activities in the coastal marine area adjacent to 282 Rangihoua Road, Purerua Peninsula, Te Puna Inlet, Bay of Islands |
02/04/2024 |
Section 92 request for additional information regarding ecological effects has been satisfied. The council has subsequently assessed that there are potentially affected persons due to navigation issues caused by the intrusion of the jetty into a narrow channel. The council has asked the applicant to gain the written approval of a number of persons prior to it making a decision on notification. |
|
APP.045927 |
C R Cashmore |
Non MM4 swing mooring in Mukimuki Bay, Bay of Islands |
17/06/2024 |
On Section 92 hold awaiting further information on ecological and cultural effects. Due to the lack of provision of the Section 92 information, the council to make a decision on whether to publicly notify the application or return it under new provisions of the Resource Management Act. |
|
APP.005055 |
Northport Limited |
Replacement consents for dredging of the Turning Basin and associated activities at Marsden Point, Whangarei Harbour |
11/09/2024 |
The council has requested the applicant to withdraw this application as the activity is included in a recent suite of consents granted for the Port expansion. |
|
APP.046222 |
P Cullinan |
Earthworks in a flood zone, Mangawhai |
13/11/2024 |
On Section 92 hold awaiting further information on a natural inland wetland. The applicant has advised that they will provide requested information in the near future. |
|
APP.008603 |
Norsand Limited |
Undertake construction of canals, maintenance dredging, and discharge of stormwater and washwater into the CMA, being the Hatea River |
24/02/2025 |
The Application was limited notified with no submissions received. The applicant and the council are discussing draft conditions of consent. |
|
APP.046445 |
Far North District Council |
Public stormwater network upgrade at Parkdale Crescent and Allen Bell Drive, Kaitāia |
17/03/2025 |
The council is awaiting written approval of a potentially affected landowner prior to determining notification of the application. |
Attachments/Ngā tapirihanga
Nil
Audit and Risk Committee ITEM: 7.0
19 May 2026
|
TITLE: |
Whakarāpopototanga / Executive Summary
The purpose of this report is to recommend that the public be excluded from the proceedings of this meeting to consider the confidential matters detailed below for the reasons given.
1. That the public be excluded from the proceedings of this meeting to consider confidential matters.
2. That the general subject of the matters to be considered whilst the public is excluded, the reasons for passing this resolution in relation to this matter, and the specific grounds under the Local Government Official Information and Meetings Act 1987 for the passing of this resolution, are as follows:
|
Item No. |
Item Issue |
Reasons/Grounds |
|
7.1 |
Confirmation of Confidential Minutes - 17 February 2026 |
The public conduct of the proceedings would be likely to result in disclosure of information, the withholding of which is necessary to protect the privacy of natural persons, including that of deceased natural persons s7(2)(a). |
|
7.2 |
Receipt of Confidential Action Sheet |
The public conduct of the proceedings would be likely to result in disclosure of information, the withholding of which is necessary to protect the privacy of natural persons, including that of deceased natural persons s7(2)(a). |
|
7.3 |
Litigation Schedule Quarterly Report January-March 2026 |
The public conduct of the proceedings would be likely to result in disclosure of information, the withholding of which is necessary to protect the privacy of natural persons, including that of deceased natural persons s7(2)(a). |
3. That the Independent Advisors be permitted to stay during business with the public excluded.
Considerations
1. Significance and Engagement
This is a procedural matter required by law. Hence when assessed against council policy is deemed to be of low significance.
2. Policy and Legislative Compliance
The report complies with the provisions to exclude the public from the whole or any part of the proceedings of any meeting as detailed in sections 47 and 48 of the Local Government Official Information Act 1987.
3. Other Considerations
Being a purely administrative matter; Climate Impact, Environmental Impact, Community Views, Māori Impact Statement, Financial Implications, and Implementation Issues are not applicable.
